OCIC Office Building Progress Record

May 2020

Status: completed

Official Handover Ceremony: 16 June 2020

Learn more about handover ceremony

March 2020

STRUCTURE WORK : Done.
MEP WORK : Equipment installation done. T & C in progress.
ARCHITECTURAL WORK : Facade painting, louver and green wall installation in done. Internal work remaining painting, ID works and De-snag.
EXTERNAL WORK : De-snag for Ground Floor external soft scape and landscape.

January 2020

STRUCTURE WORK : Done.
MEP WORK : Equipment installation in progress, start testing and commissioning.
ARCHITECTURAL WORK : Facade painting, louver and green wall installation in progress. Internal building starts cleaning and snagging.
EXTERNAL WORK : Ground Floor external soft scape and landscape in progress.

November 2019

STRUCTURE WORK: Done.
MEP WORK : MEP 1st fix done and 2nd Fix L20 & L21, MEP Work 3rd Fix L6 to L8.

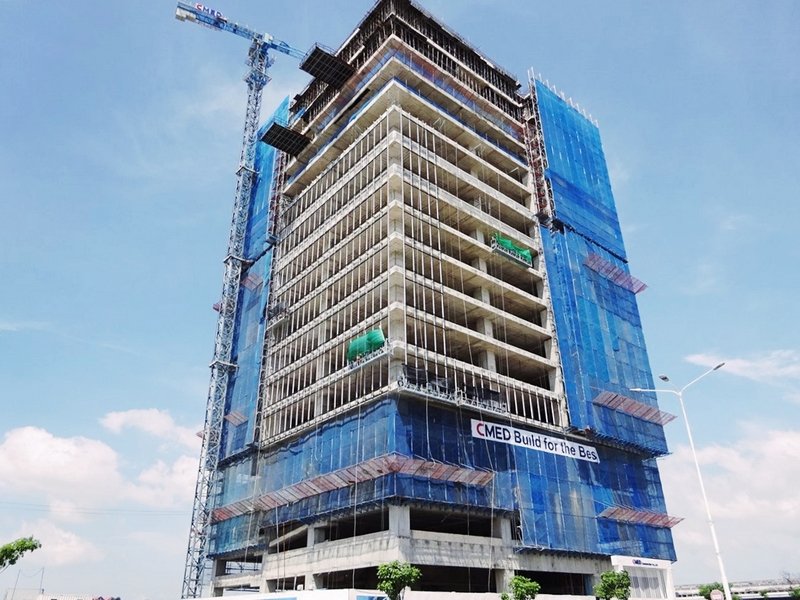

ARCHITECTURAL WORK : External Plastering Up to L18, Wet work (tiling) at G to L17, Painting work in progress (Skim coat) L1 to L15.
EXTERNAL WORK : Fencing foundation in progress.

September 2019

STRUCTURE WORK : L21 column and core wall in progress.
MEP WORK : MEP 1st fix up to 21F and MEP 2nd fix up to L18.

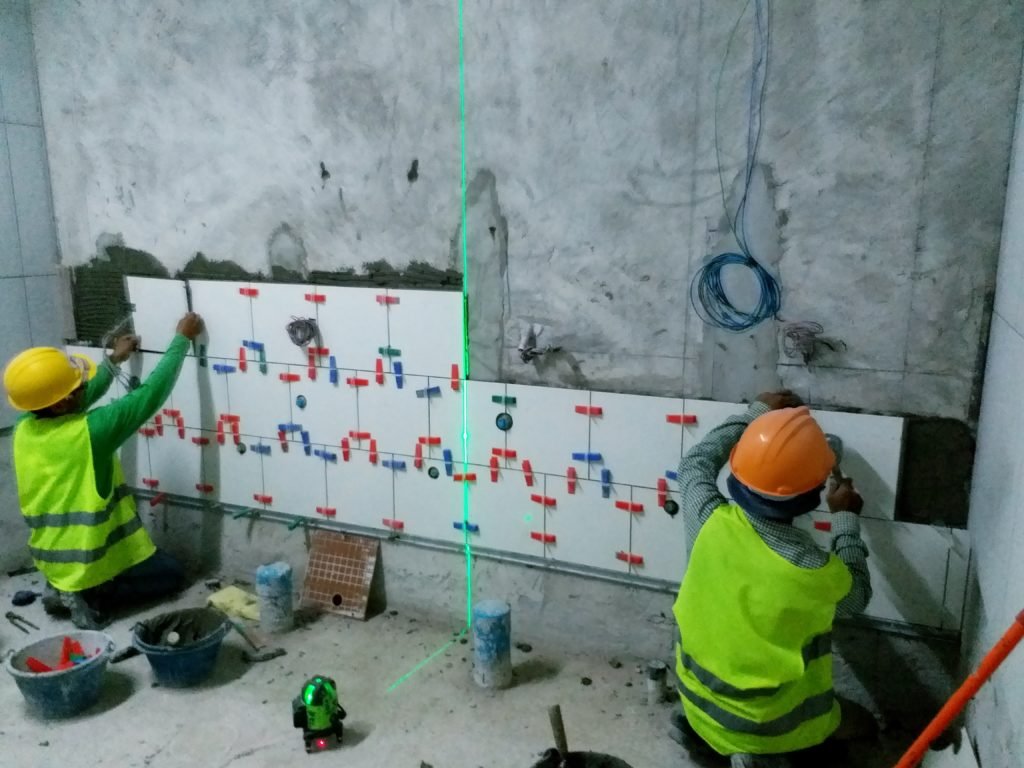

ARCHITECTURAL WORK : Installing block wall up to L18, Plastering work up to L8 Waterproofing up to L9, Tiling work at GF toilet.
EXTERNAL WORK : Shift rebar yard for external sub base and facing work.

July 2019

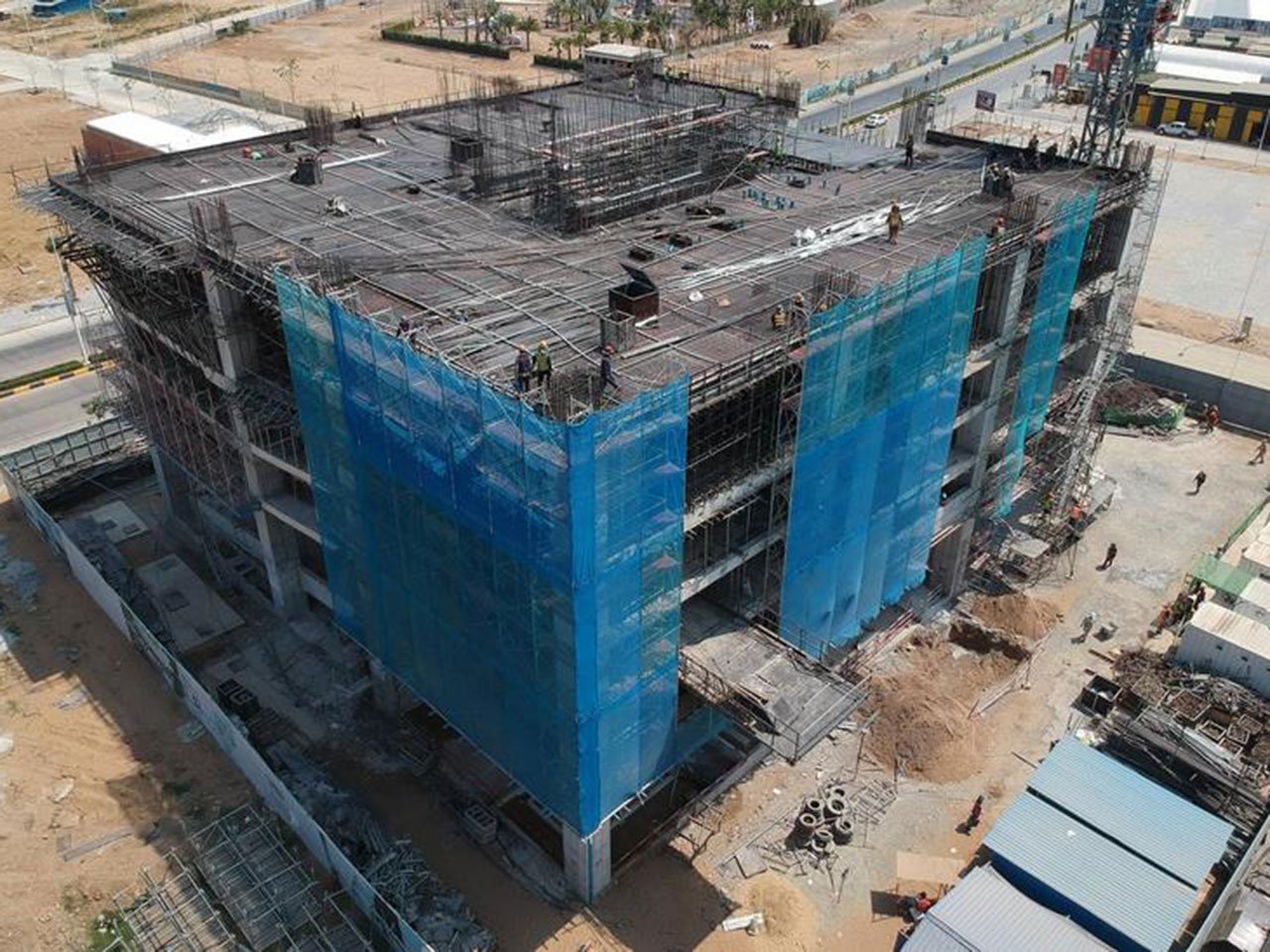

STRUCTURE WORK : L19 in progress.
MEP WORK : MEP 1st fix up to 19F and MEP 2nd fix up to L12.
ARCHITECTURAL WORK : Wet trade at G to L8, (block installation), Plastering L3 & 5F.

May 2019

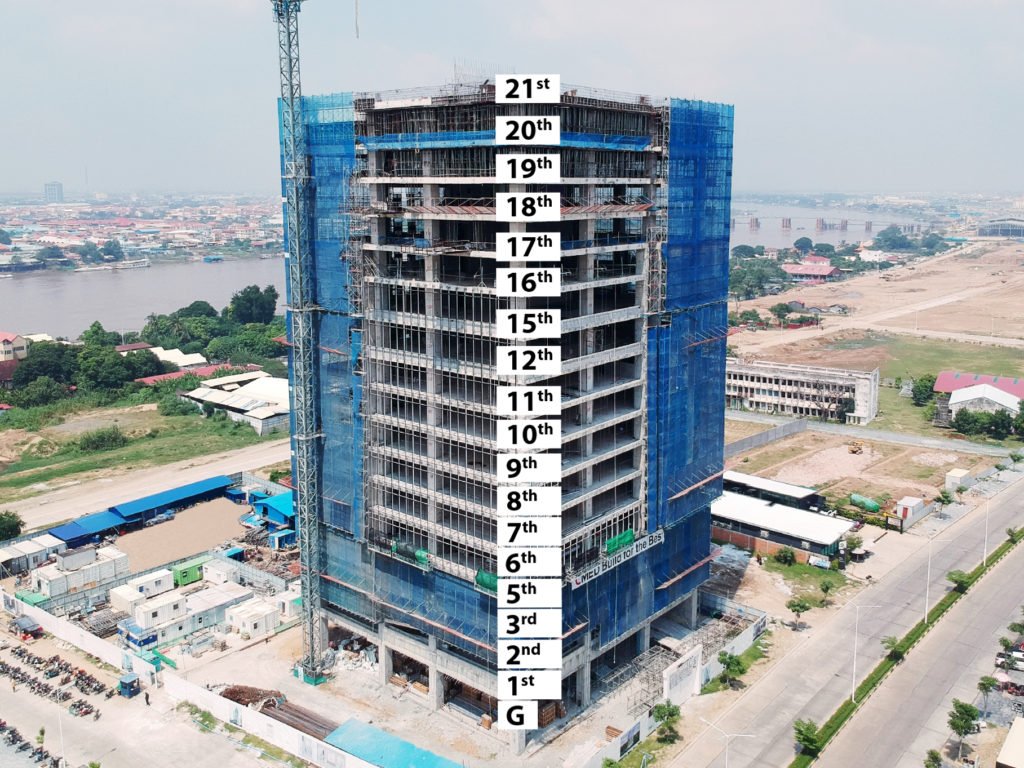

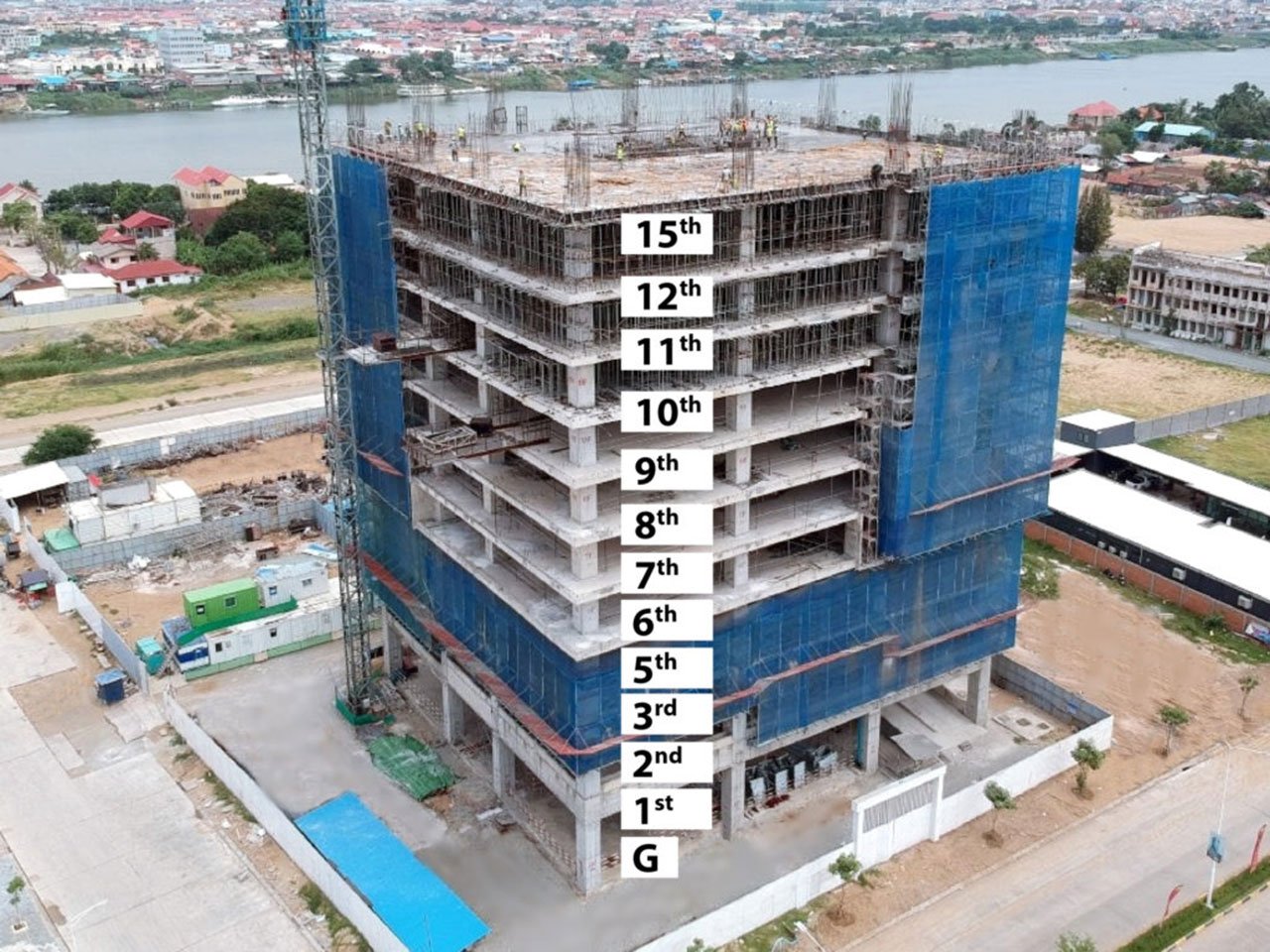

STRUCTURE WORK : Construction stage of Super Structure (15th floor Slab form In Progress). The main activity is concrete structure work.
MEP WORK : MEP 1st fix up to 15F, MEP 2nd fix up to 5F.

March 2019

STRUCTURE WORK : Construction stage of Super Structure (12th floor Slab form In Progress). The main activity is concrete structure work.
MEP WORK : MEP 1st fix up to 12F.

January 2019

STRUCTURE WORK : Construction stage of Super Structure (6th floor). The main activity is concrete structure work.
MEP WORK : MEP 1st fix up to 6F.

November 2018

STRUCTURE WORK : Construction stage of Super Structure (2nd floor in progress).
MEP WORK :1st fix up to 2F.

September 2018

STRUCTURE WORK : Construction stage of Super Structure (GF column and core wall).
MEP WORK : MEP 1st at GF.

July 2018

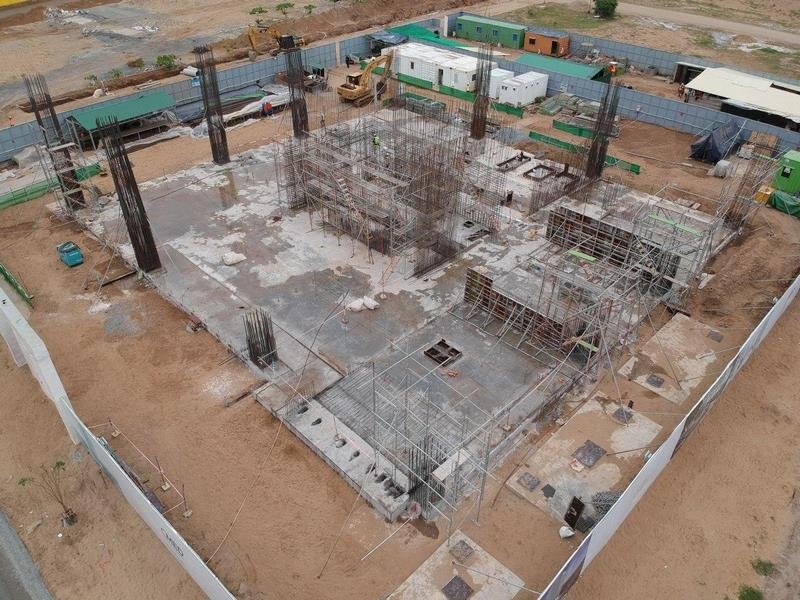

Ground floor slab done.
GF to 1F core wall and column rebar installation in progress.
Soil: leveling for external soil

May 2018

MEP underground work in progress.
Substructure works (pile cap, STP tank and underground water tank) in progress and soil back filling.

March 2018

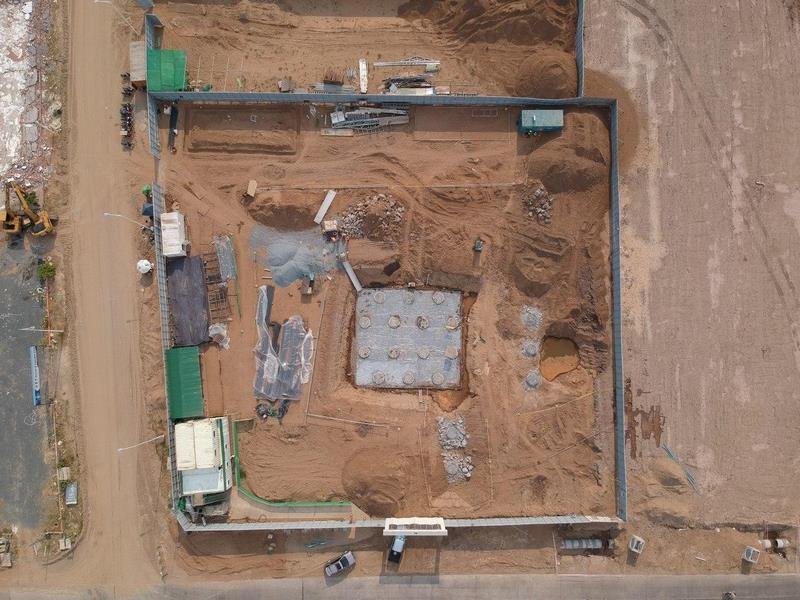

Pile load test is done.

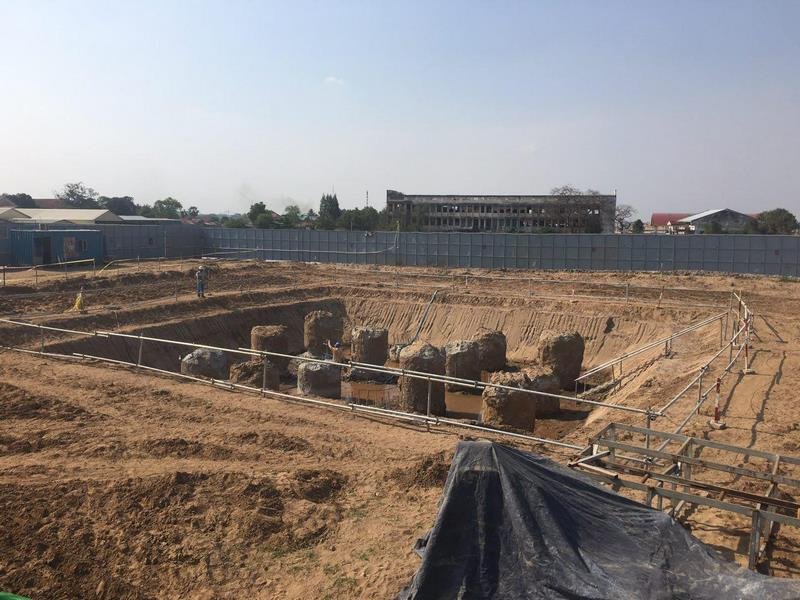

Excavation pile cap and pile head cap.

January 2018

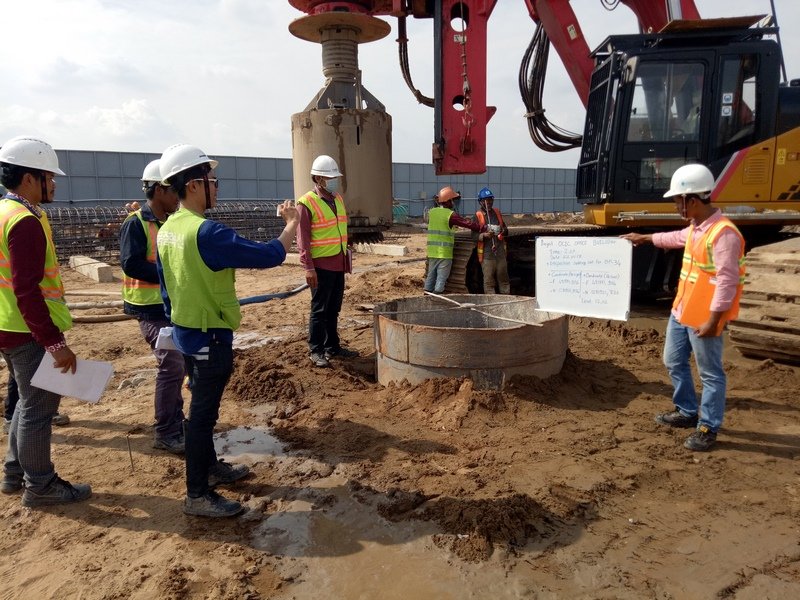

Bore pile works in progress.

November 2017

Mobilize machinery to start bore pile work.

2019.11.29
