L’attrait Boeung Keng Kang Progress Record

October 2021

Status: completed

Official Handover Ceremony: 20 October 2021

Learn more about handover ceremony







May 2021

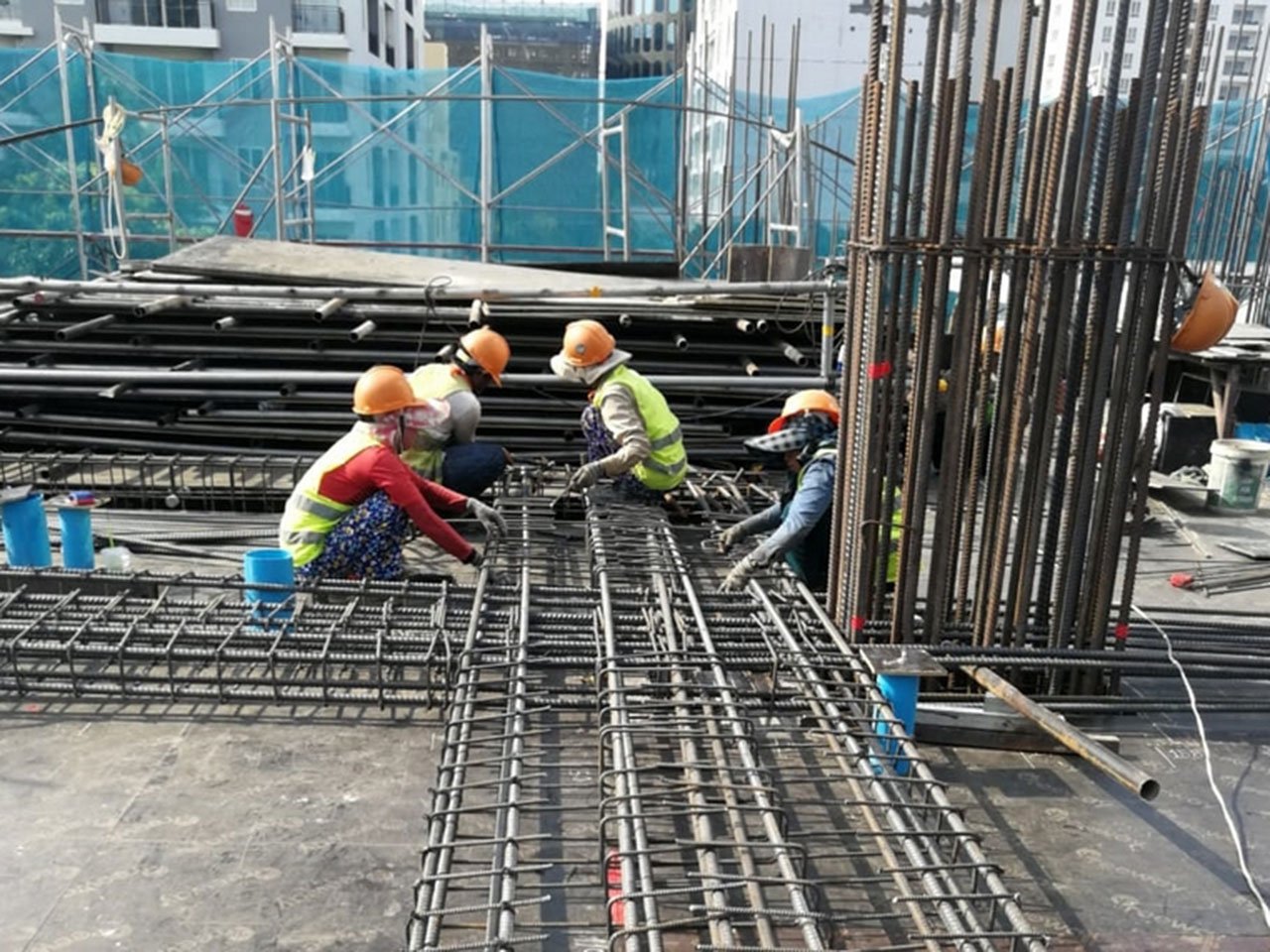

STRUCTURE WORK: Completed

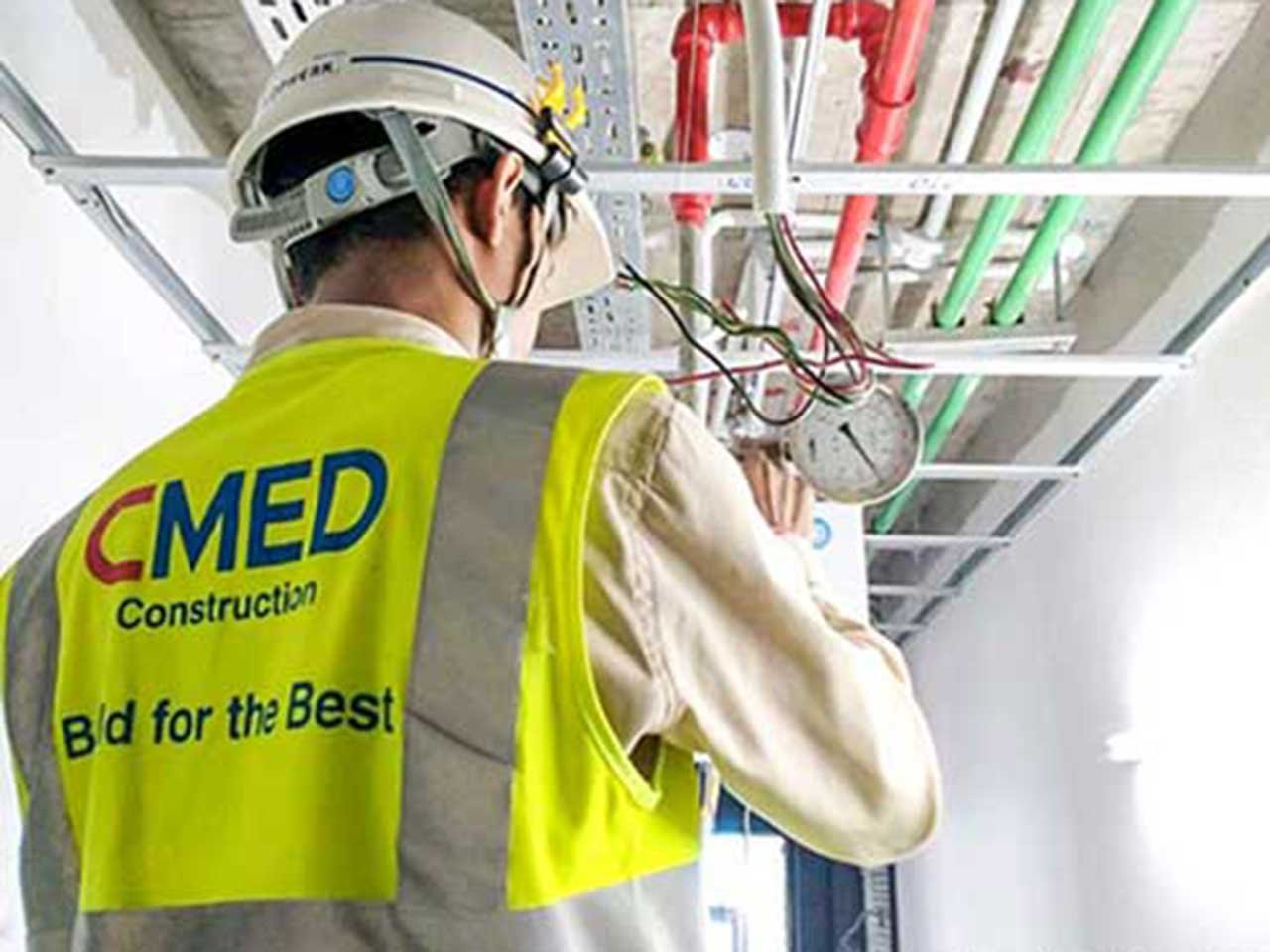

MEP WORK:
• 1st fix completed
• 2nd fix completed
• 3rd fix completed
• Test & Commissioning in progress
ARCHITECTURAL WORK:

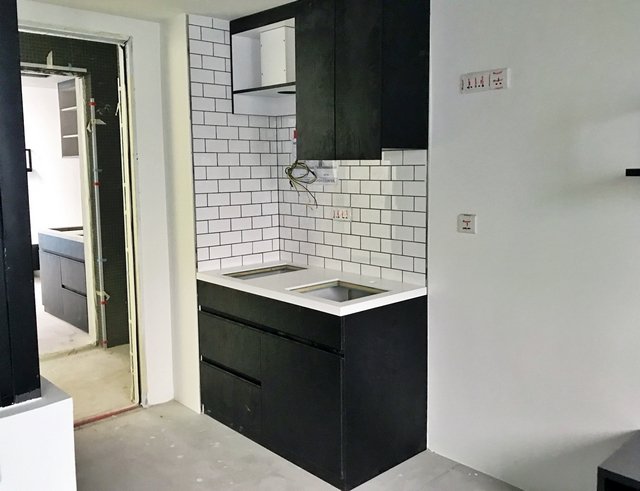

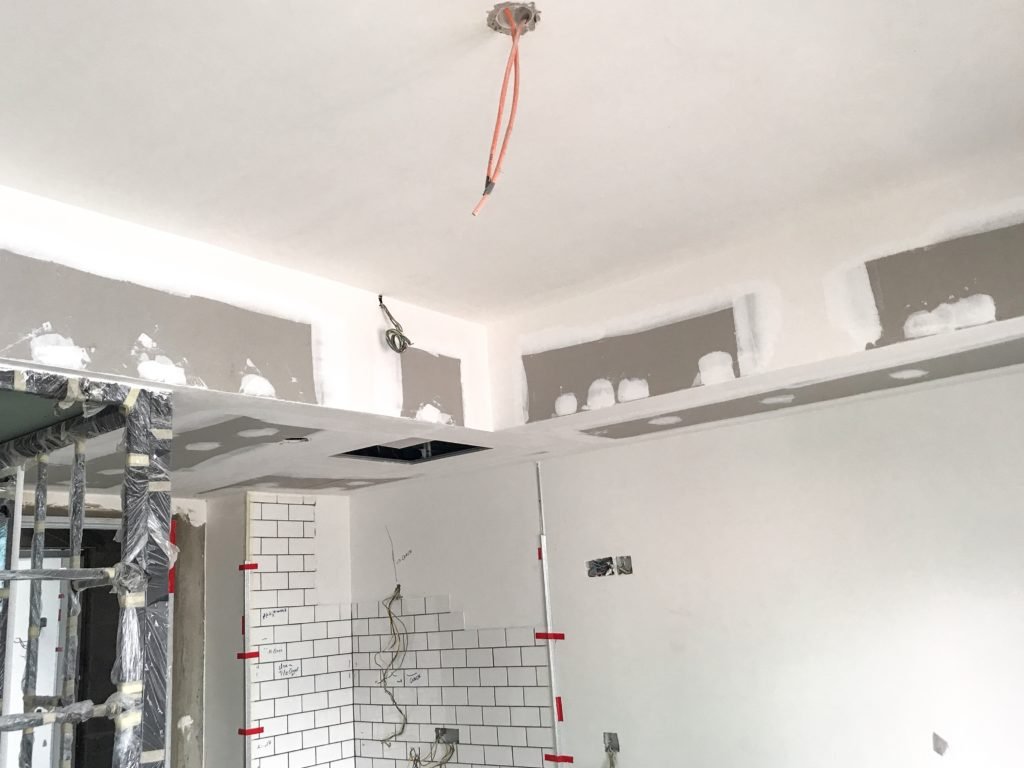

• Studio & 1 bedroom – completed Client Handing Over Inspection in progress
• 2 bedrooms and penthouse – completed Internal snagging & touch up work in progress
EXTERNAL WORK:

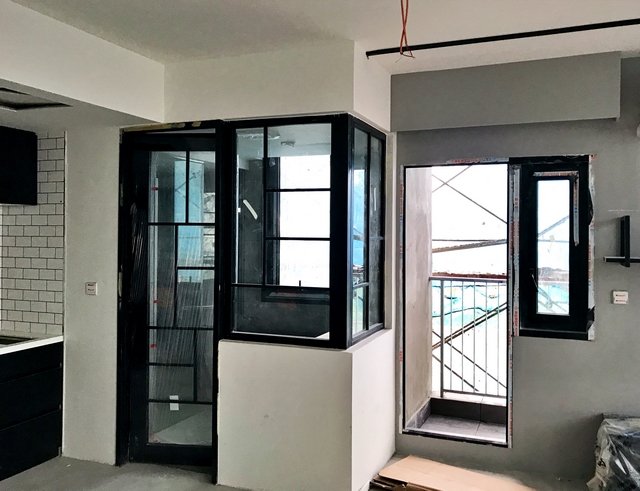

• Window, external plastering & external wall painting – completed
• External window & wall cleaning in progress

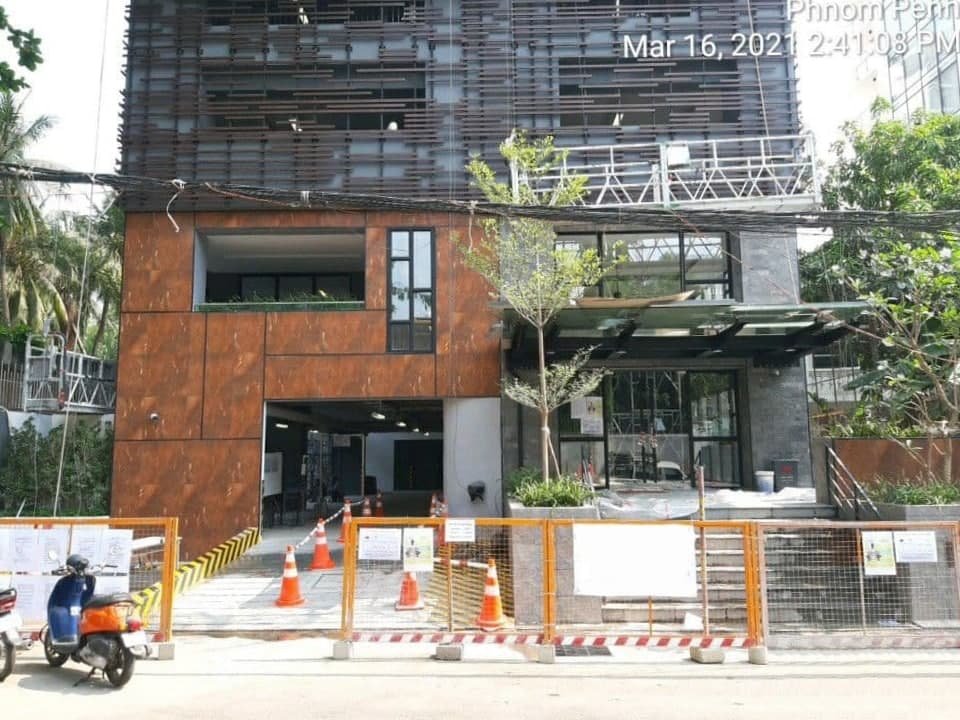

February 2021

STRUCTURE WORK: Completed
MEP WORK:
• 1st fix completed
• 2nd fix completed
• 3rd fix completed

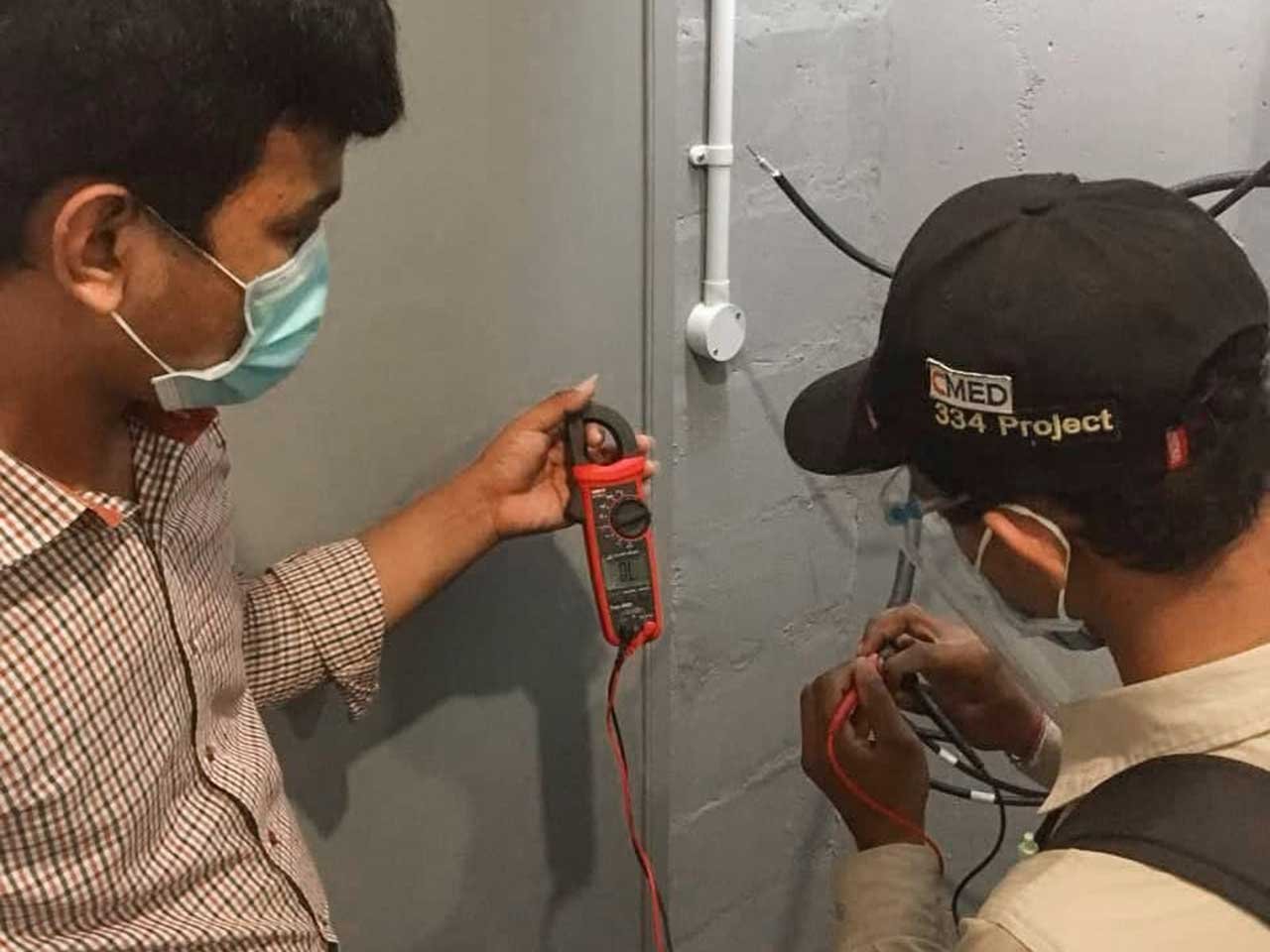

• Final test and commissioning for overall building functionality in progress
ARCHITECTURAL WORK:
• Studio & 1 bedroom – Completed
• 2 bedrooms and penthouse – build in Furniture installation and internal
snagging in progress
• Common area, facilities floor & External Façade – snagging in progress
EXTERNAL WORK: Snagging in progress



December 2020

STRUCTURE WORK: Completed
MEP WORK:
• 1st fix completed
• 2nd fix completed
• 3rd fix testing & commissioning in progress
ARCHITECTURAL WORK:
• Studio – Completed, snagging in progress
• 1 bedroom, 2 bedrooms and penthouseBuild in Furniture installation, touch up work in progress
EXTERNAL WORK:
• Window completed
• External plastering completed
• External Wall painting completed
• External Scaffolding dismantling in progress



October 2020

STRUCTURE WORK: Completed
MEP WORK:
• 1st fix completed
• 2nd fix completed
• 3rd fix testing in progress
ARCHITECTURAL WORK:
• Block & plastering works completed
• Water proofing works completed
• Studio – Final cleaning in progress
• 1 bedroom, 2 bedrooms and penthouse work in progress.
EXTERNAL WORK:
• Window 95% completed
• External plastering 85% completed
• External Wall painting in progress



August 2020

STRUCTURE WORK: Completed

MEP WORK:
• 1st Fix completed
• 2nd Fix – Studio completed – 1 Bed, 2 Bed, Penthouse, Facilities Floor in progress
• 3rd Fix in progress

ARCHITECTURAL WORK:
• Block & plastering works completed.
• Water proofing works 90% completed.
• Studio, 1 Bed, 2 Bed, Penthouse, Facilities Floor in progress.

EXTERNAL WORK: Window and plastering in progress



June 2020

STRUCTURE WORK: Completed
MEP WORK:

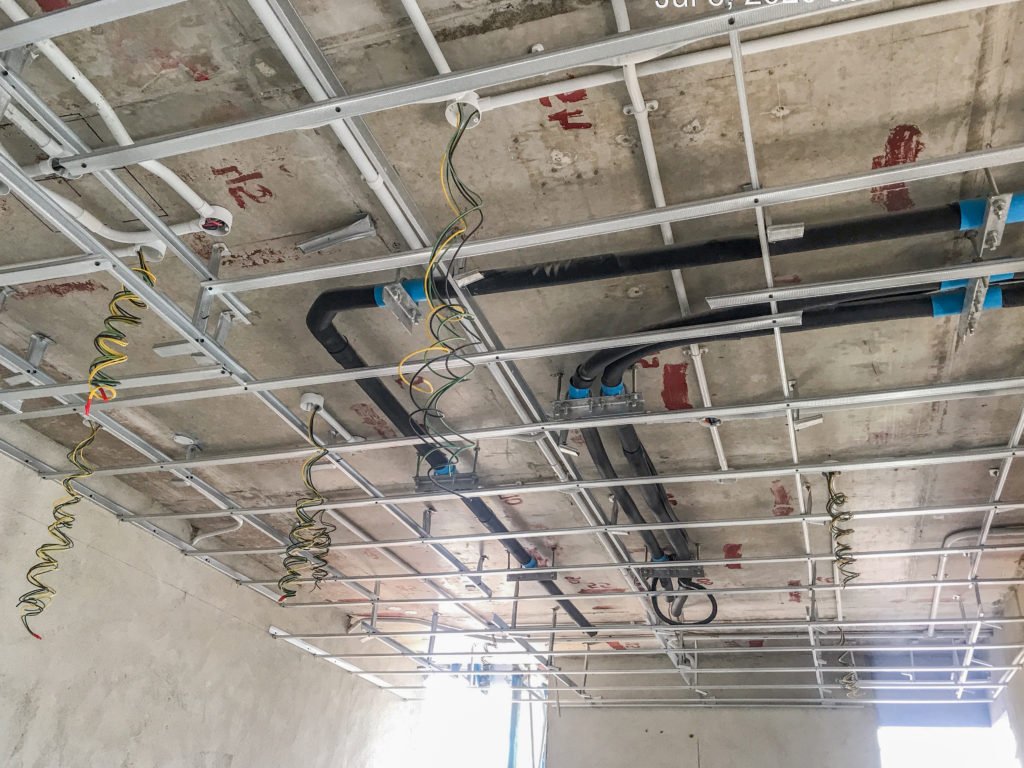

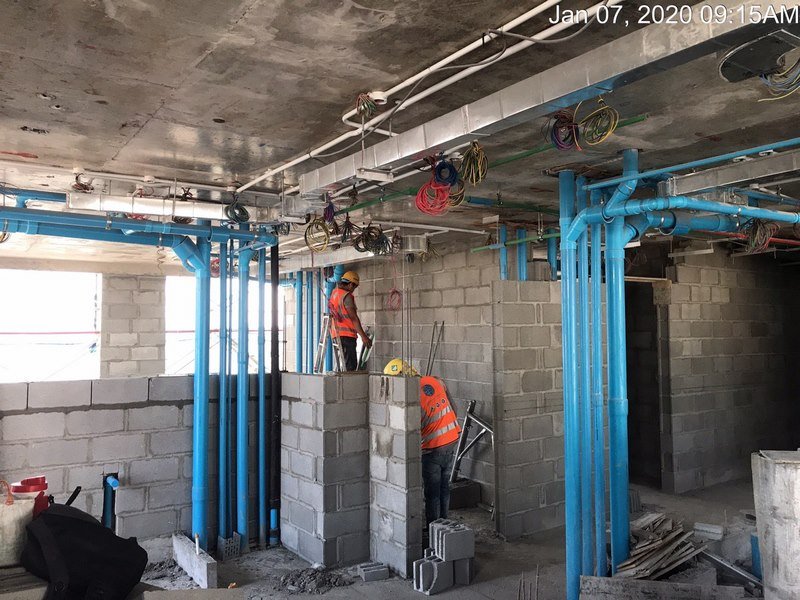

• Studio – above ceiling services completed & testing in progress
• 1 Bed, 2 Bed, Penthouse – above ceiling services & Wall conceal in progress
ARCHITECTURAL WORK:
• Studio – Interior Finishing in progress
• 1 Bed, 2 Bed, Penthouse – Wet trade block & Plastering in progress

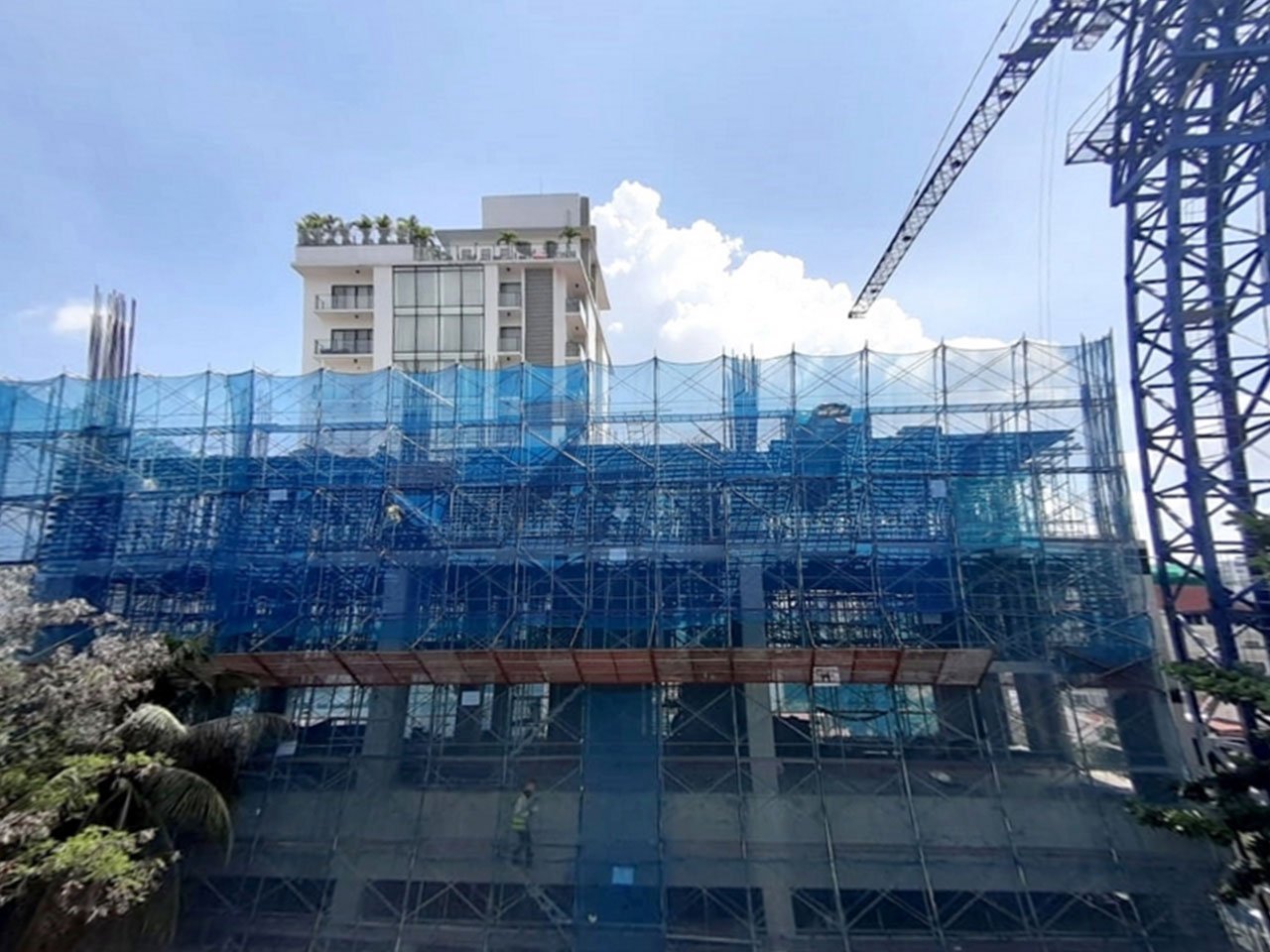

EXTERNAL WORK: External plastering, external window frame & glazing and balcony handrail installation in progress

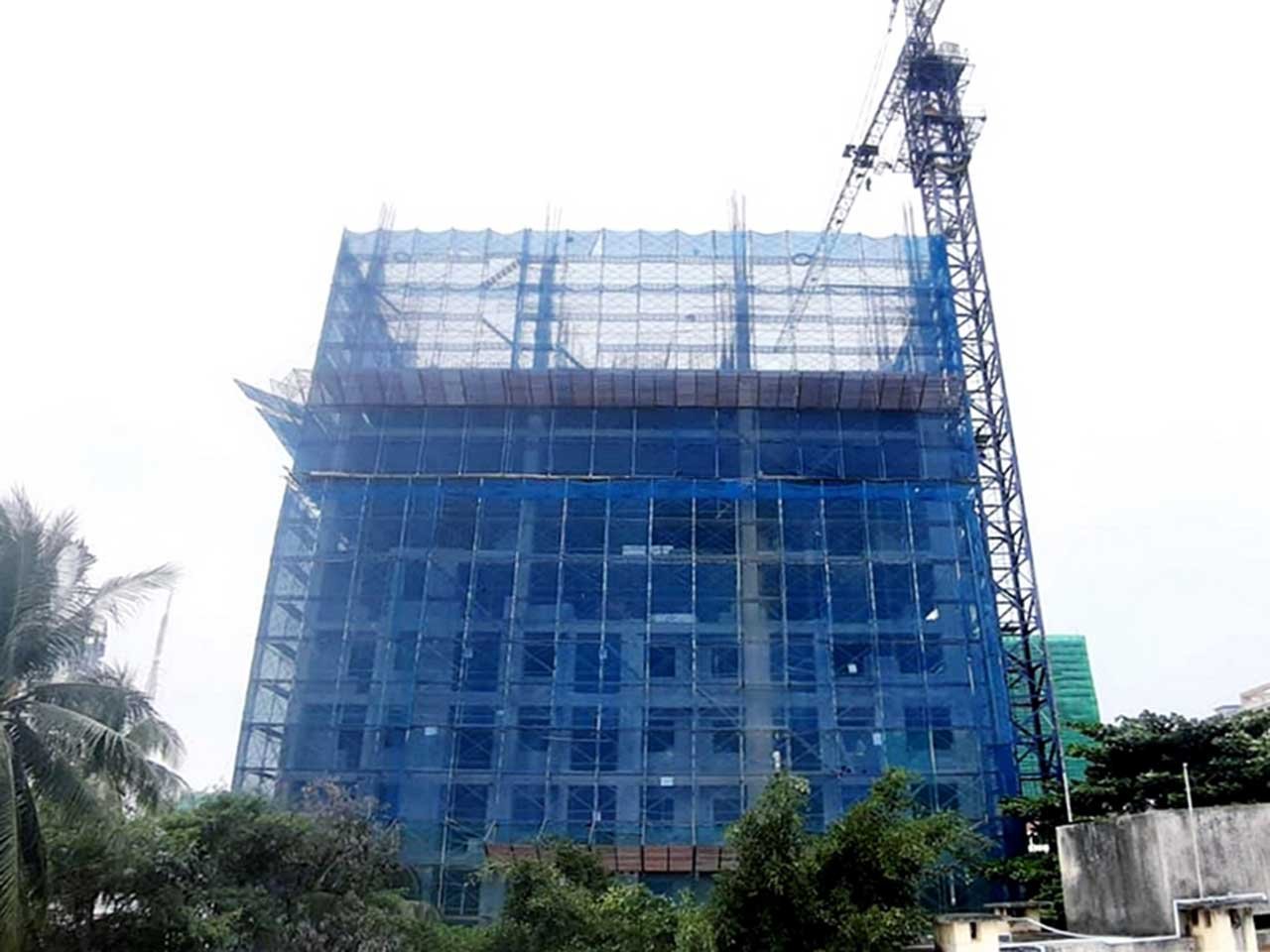

April 2020

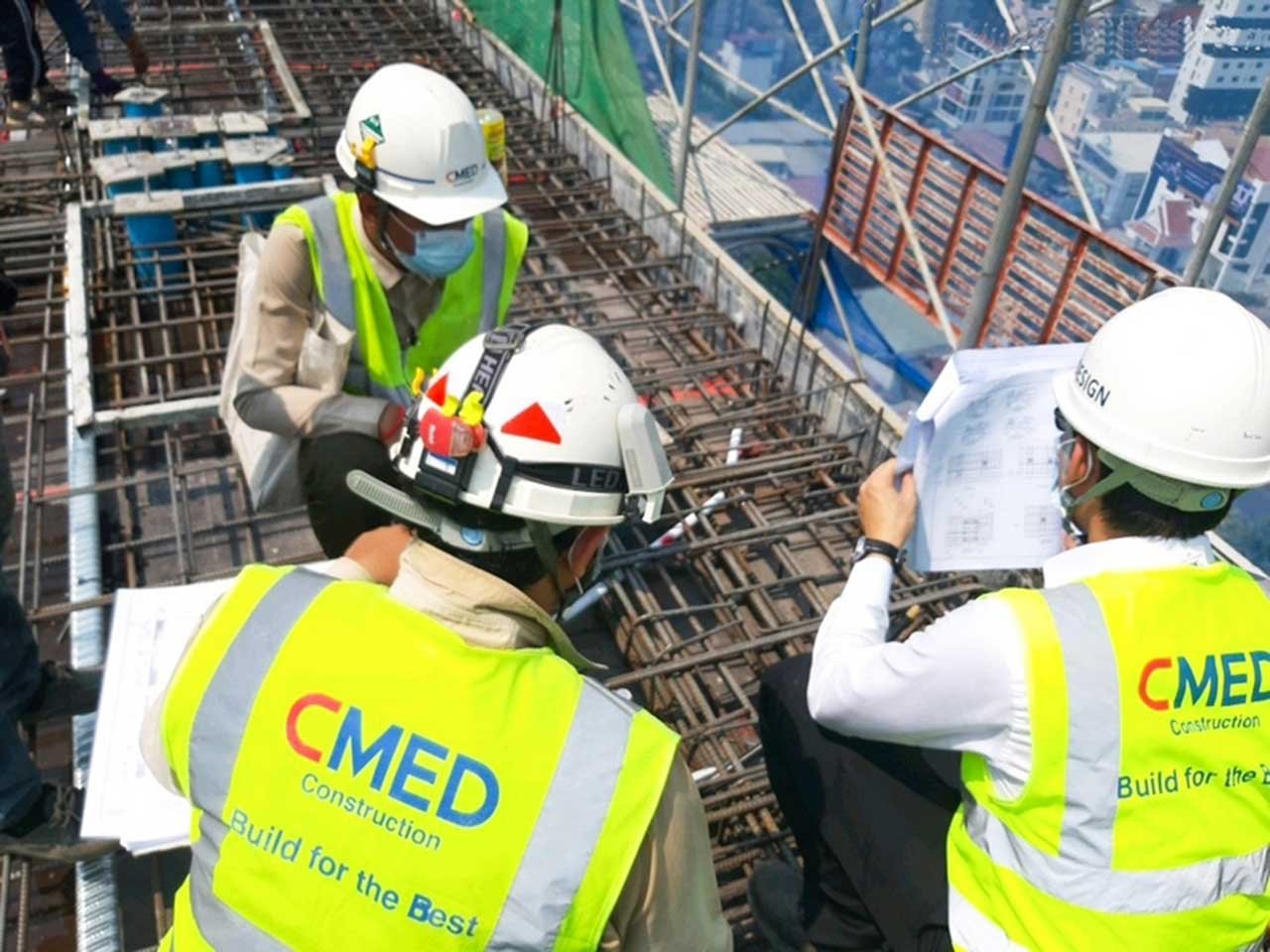

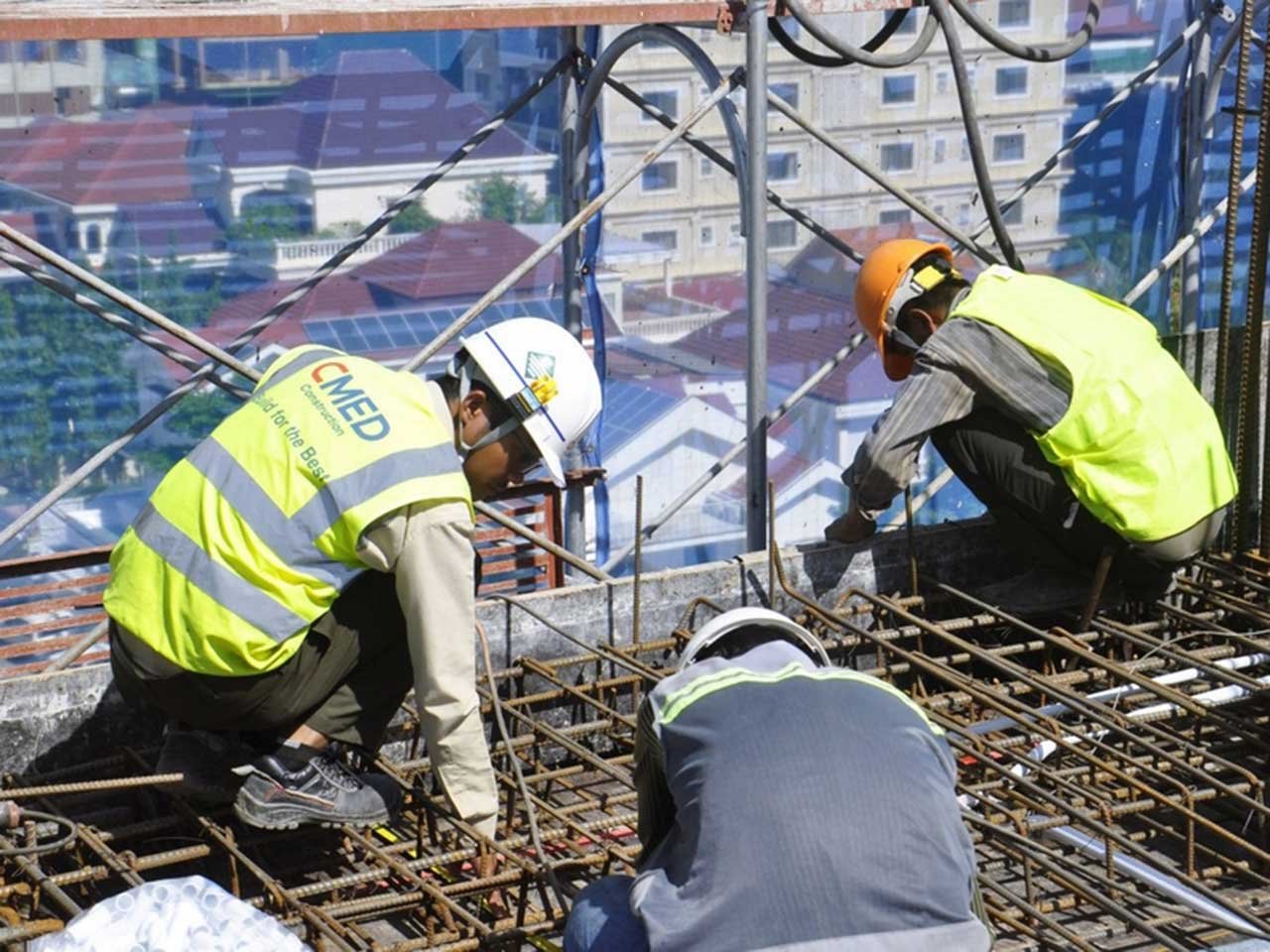

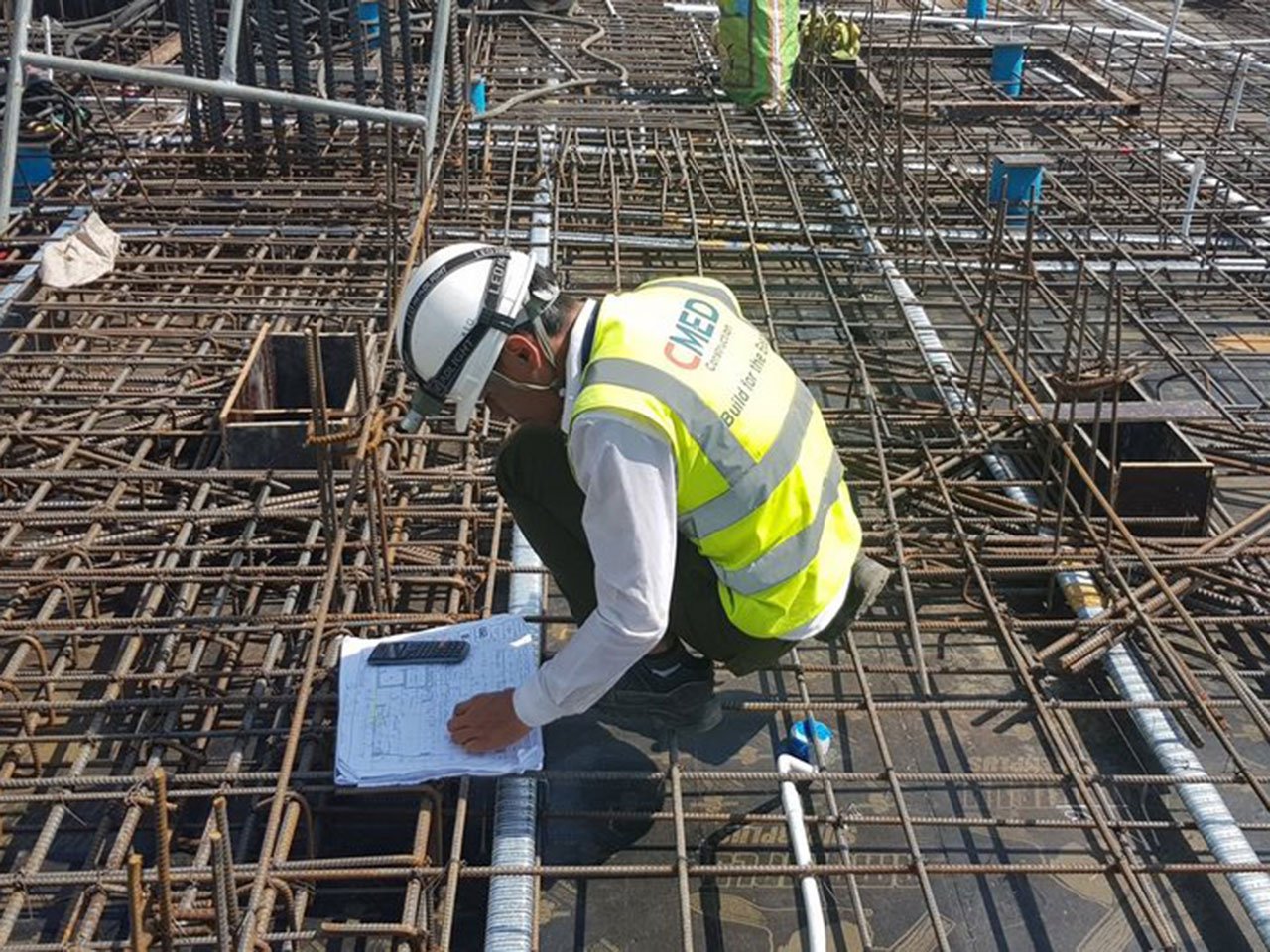

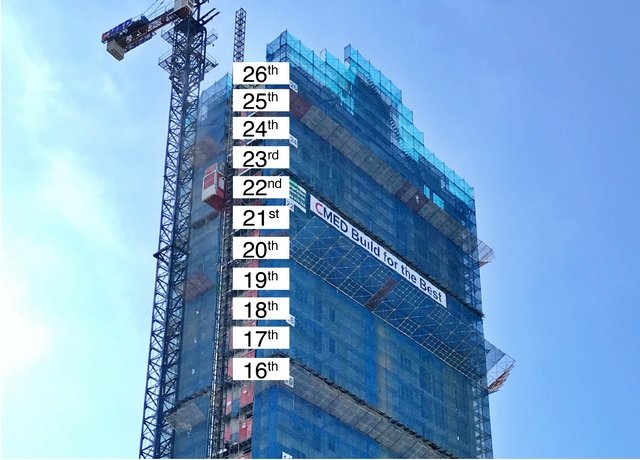

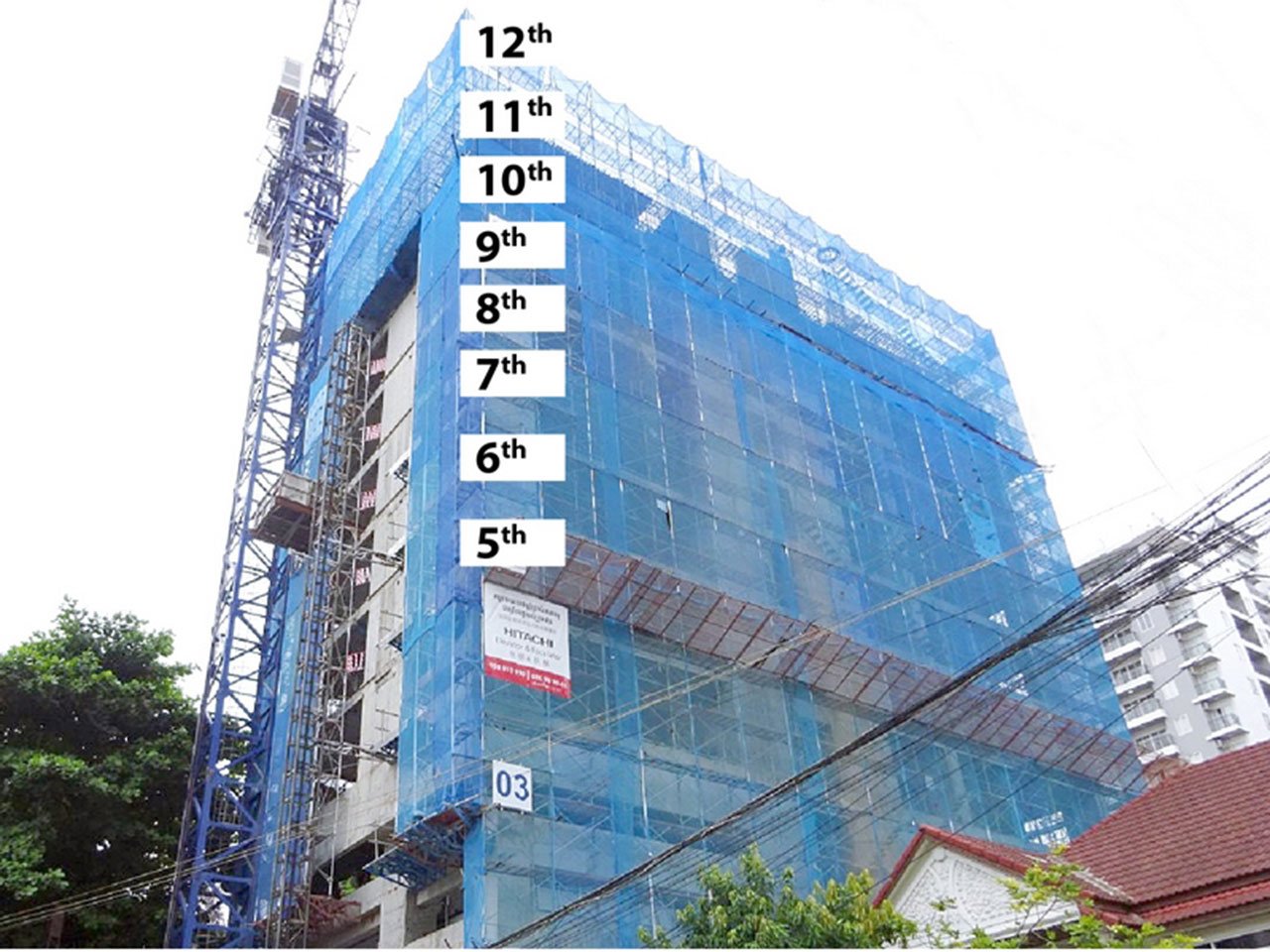

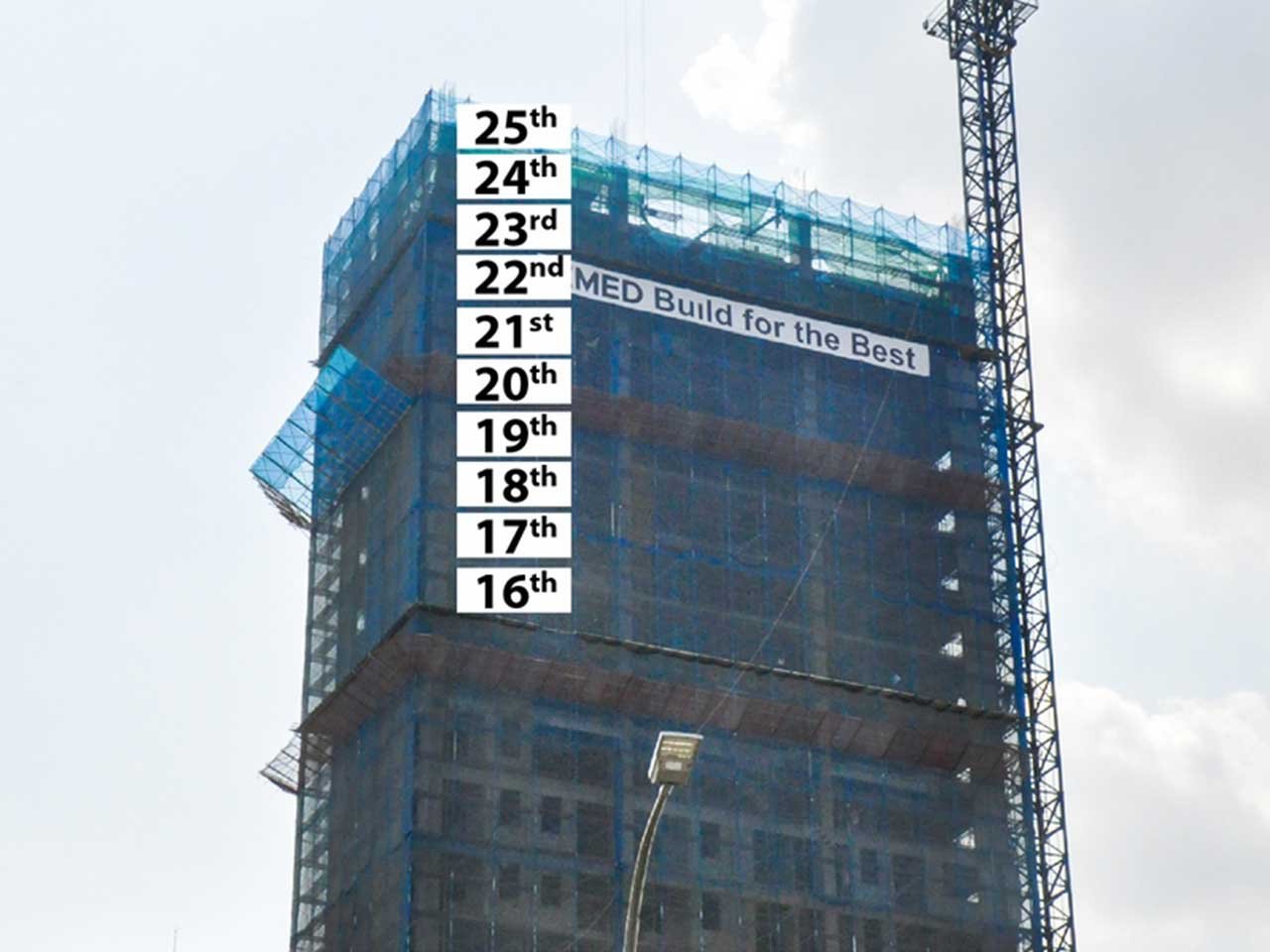

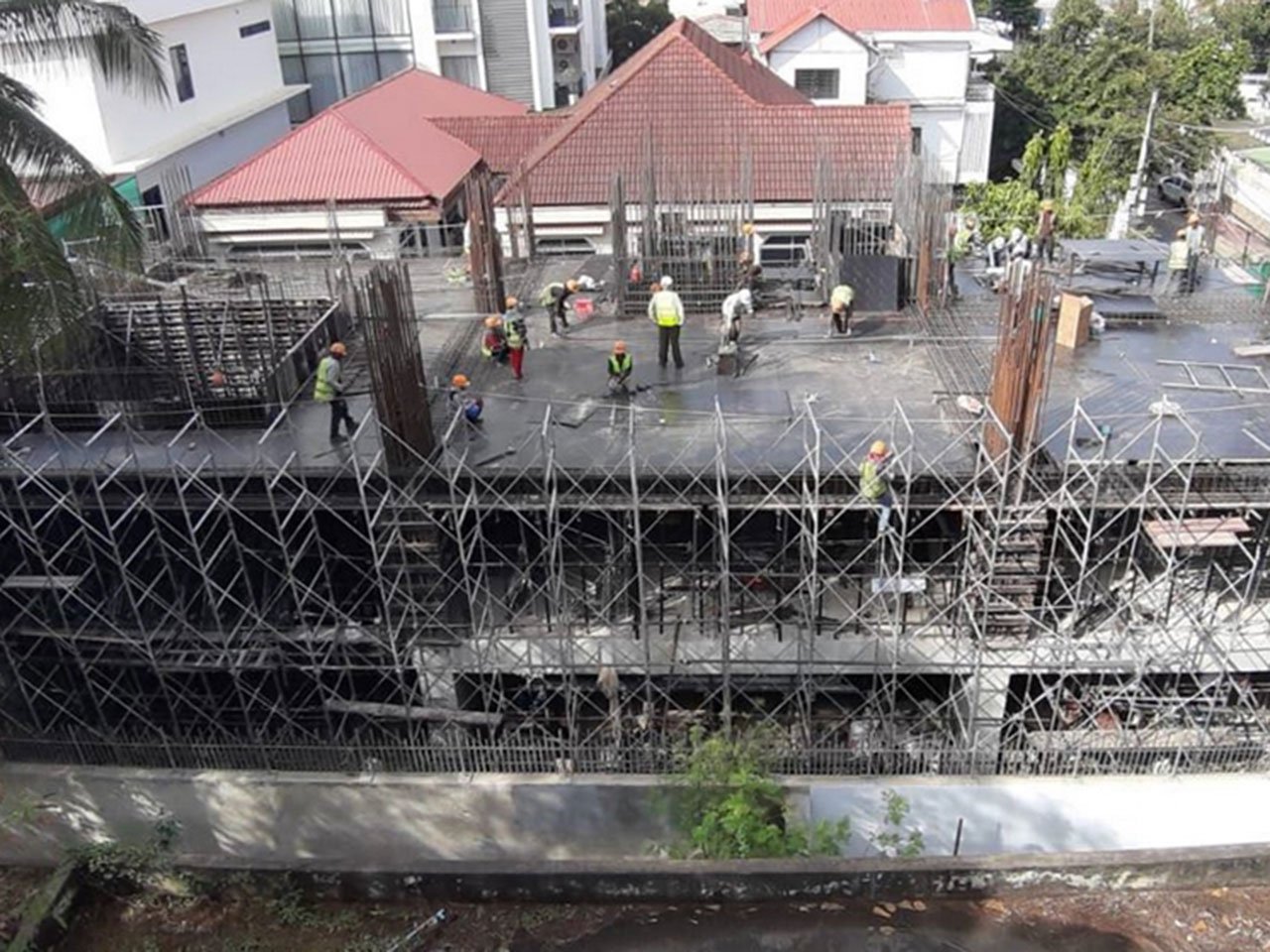

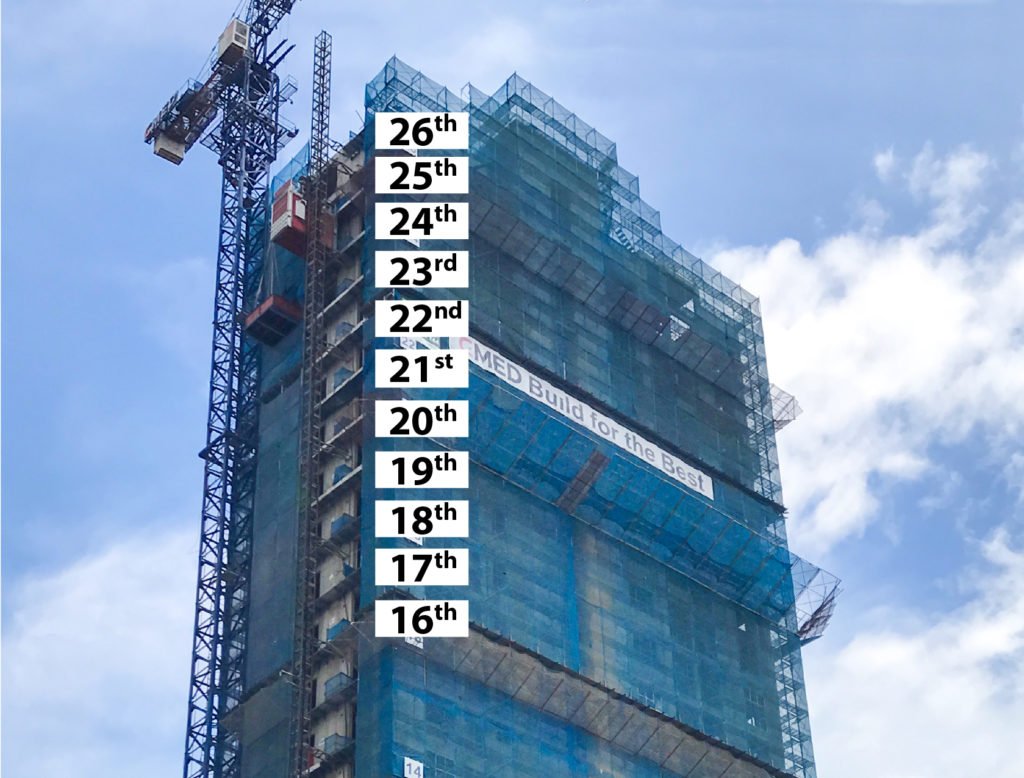

STRUCTURE WORK: L25 / L26 + Rooftop on going
MEP WORK: In progress from L1 to L21
ARCHITECTURAL WORK: L4 to L21 in progress
EXTERNAL WORK: L4 to L11 in progress



February 2020

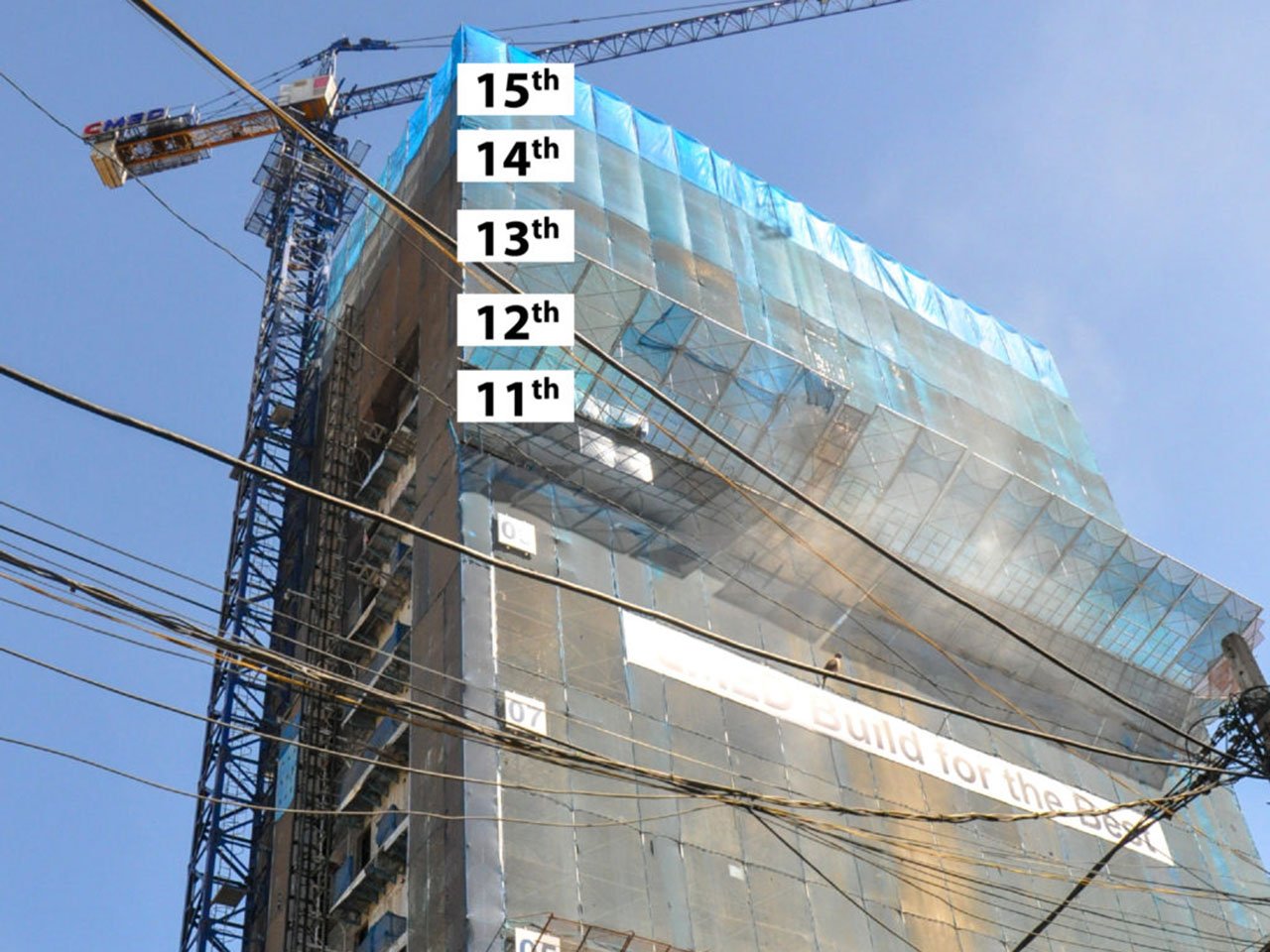

STRUCTURE WORK: L20 in progress
MEP WORK: L17 in progress
ARCHITECTURAL WORK: L4 to L14 in progress



December 2019

STRUCTURE WORK: L15 in progress
MEP WORK: L11 in progress
ARCHITECTURAL: WORK L4 to L11 in progress
Mock up unit completed



October 2019

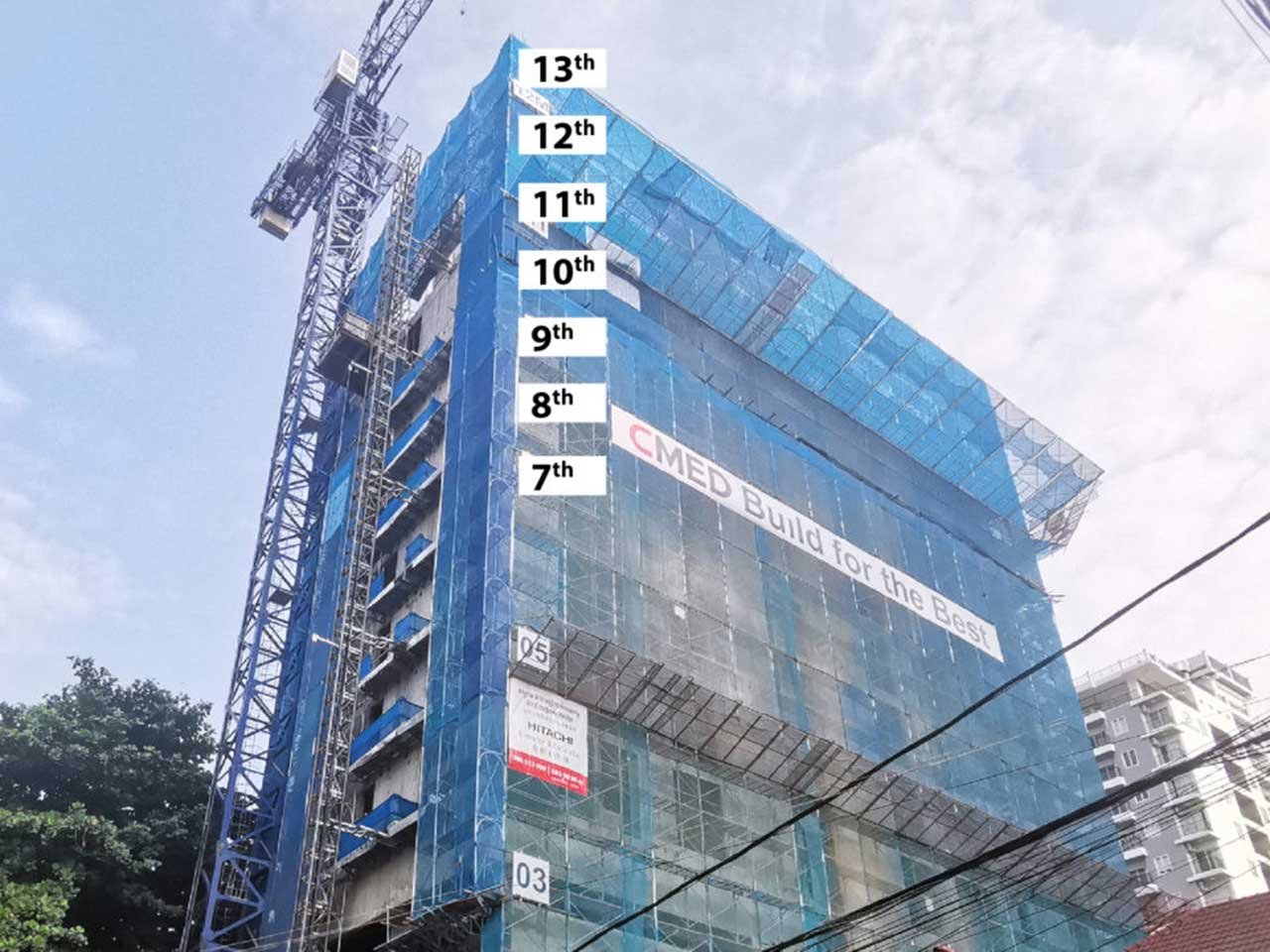

STRUCTURE WORK: L13 in progress
MEP WORK: L10 in progress
ARCHITECTURAL WORK: L4 to L11 in progress
Mock up unit in progress



August 2019

STRUCTURE WORK: L12 in progress
MEP WORK: L10 in progress
ARCHITECTURAL WORK: L4 to L7 in progress
Mock up unit in progress

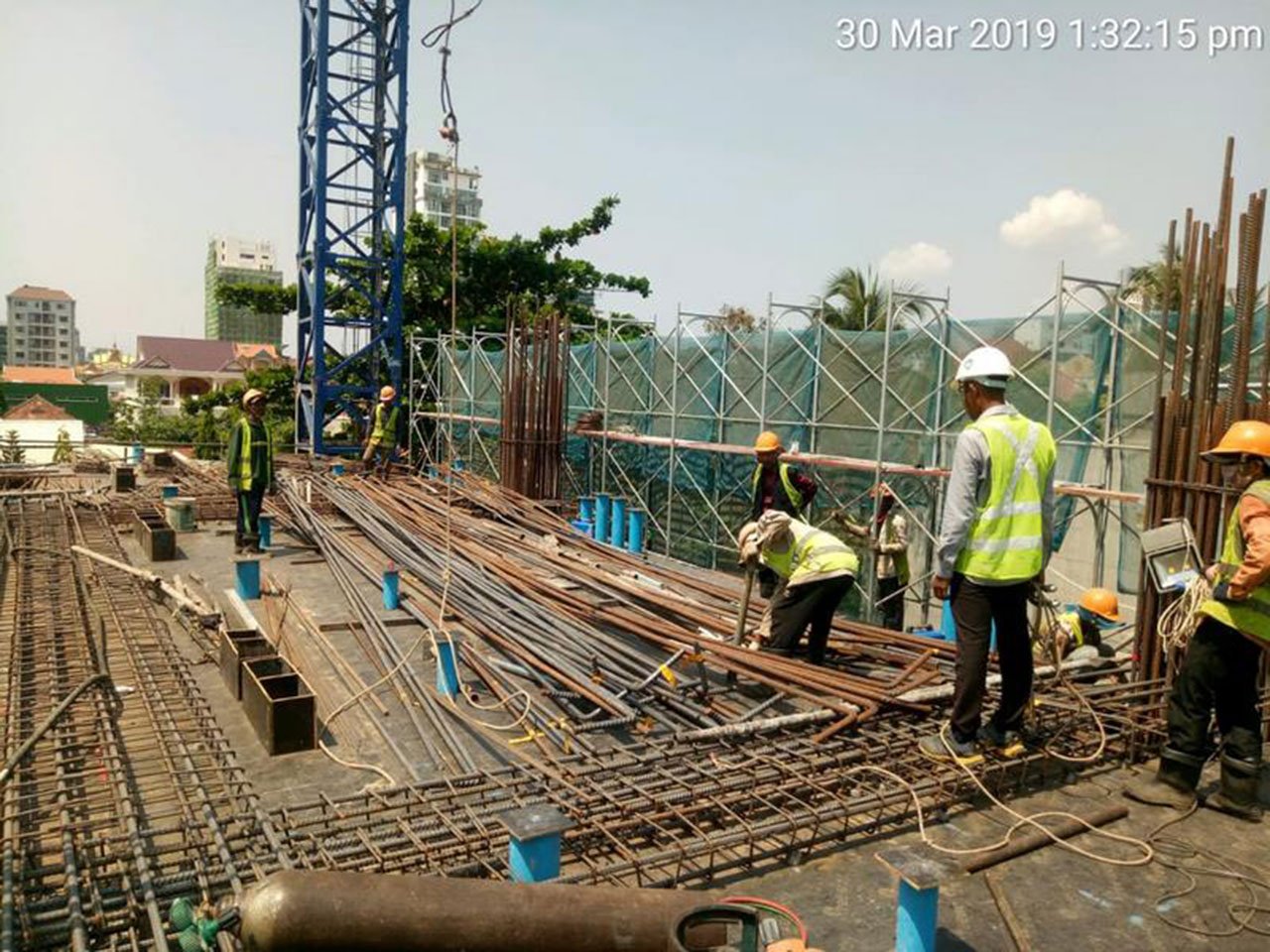

June 2019

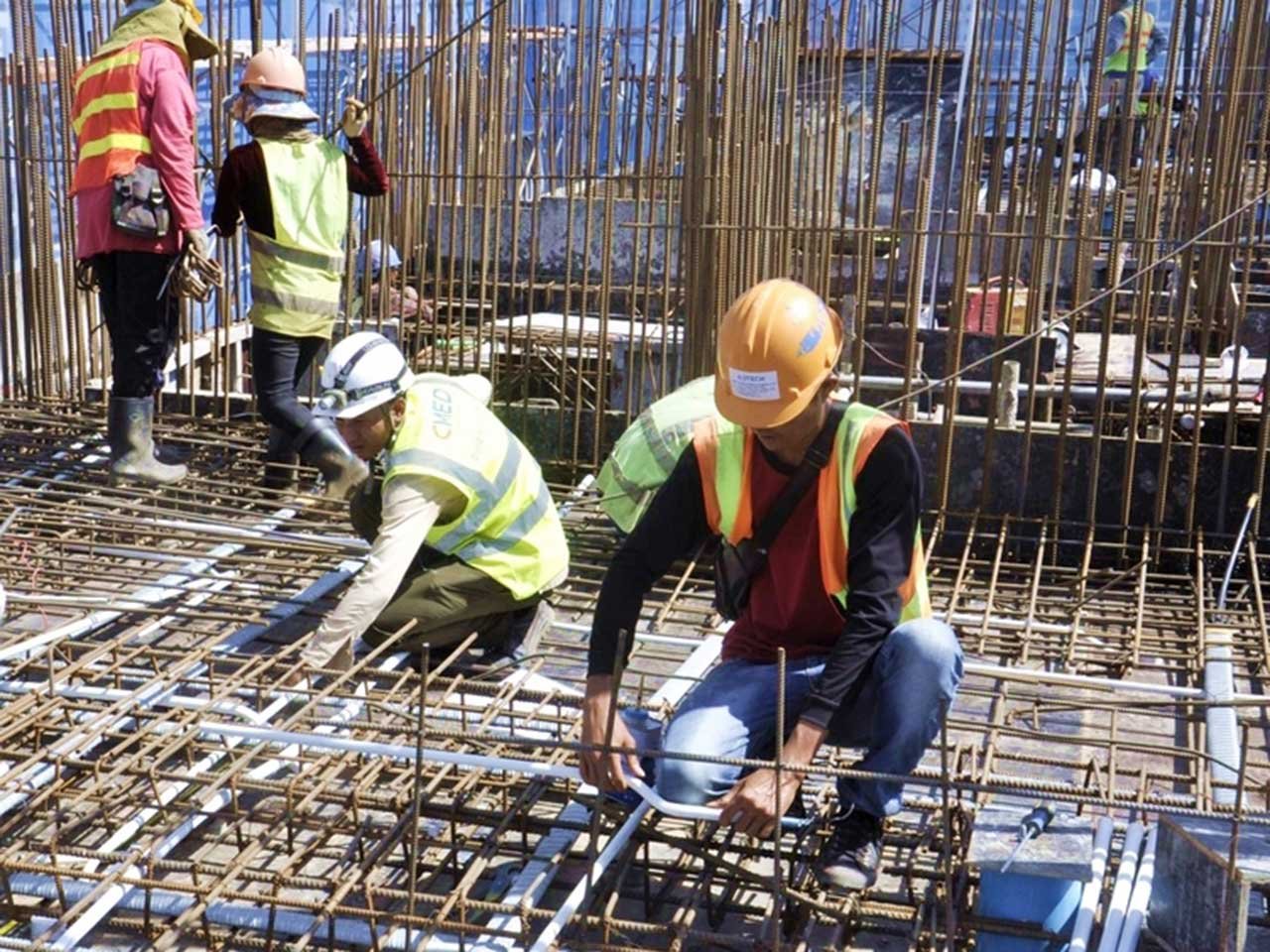

STRUCTURE WORK: L9 in progress
MEP WORK: L5 in progress
ARCHITECTURAL WORK: L4 to L5 in progress



April 2019

STRUCTURE WORK: L7 in progress
MEP WORK: L1 to L7 in progress



February 2019

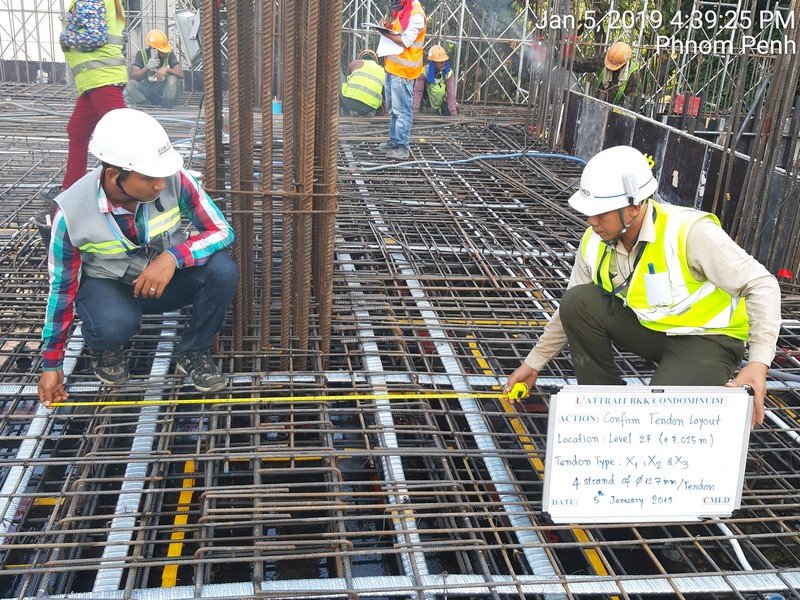

STRUCTURE WORK: L4 in progress
MEP WORK: L1 to L4 in progress

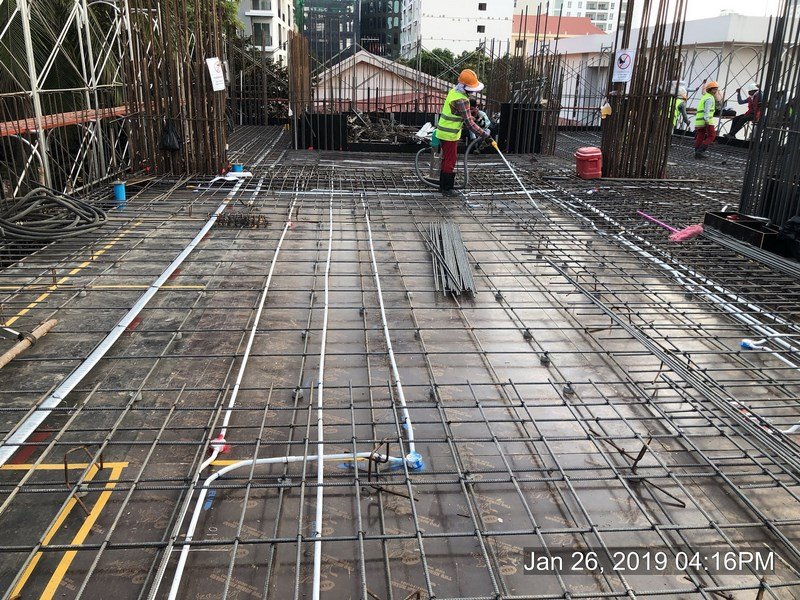

December 2018

STRUCTURE WORK: L3 in progress
MEP WORK: L1 to L3 in progress

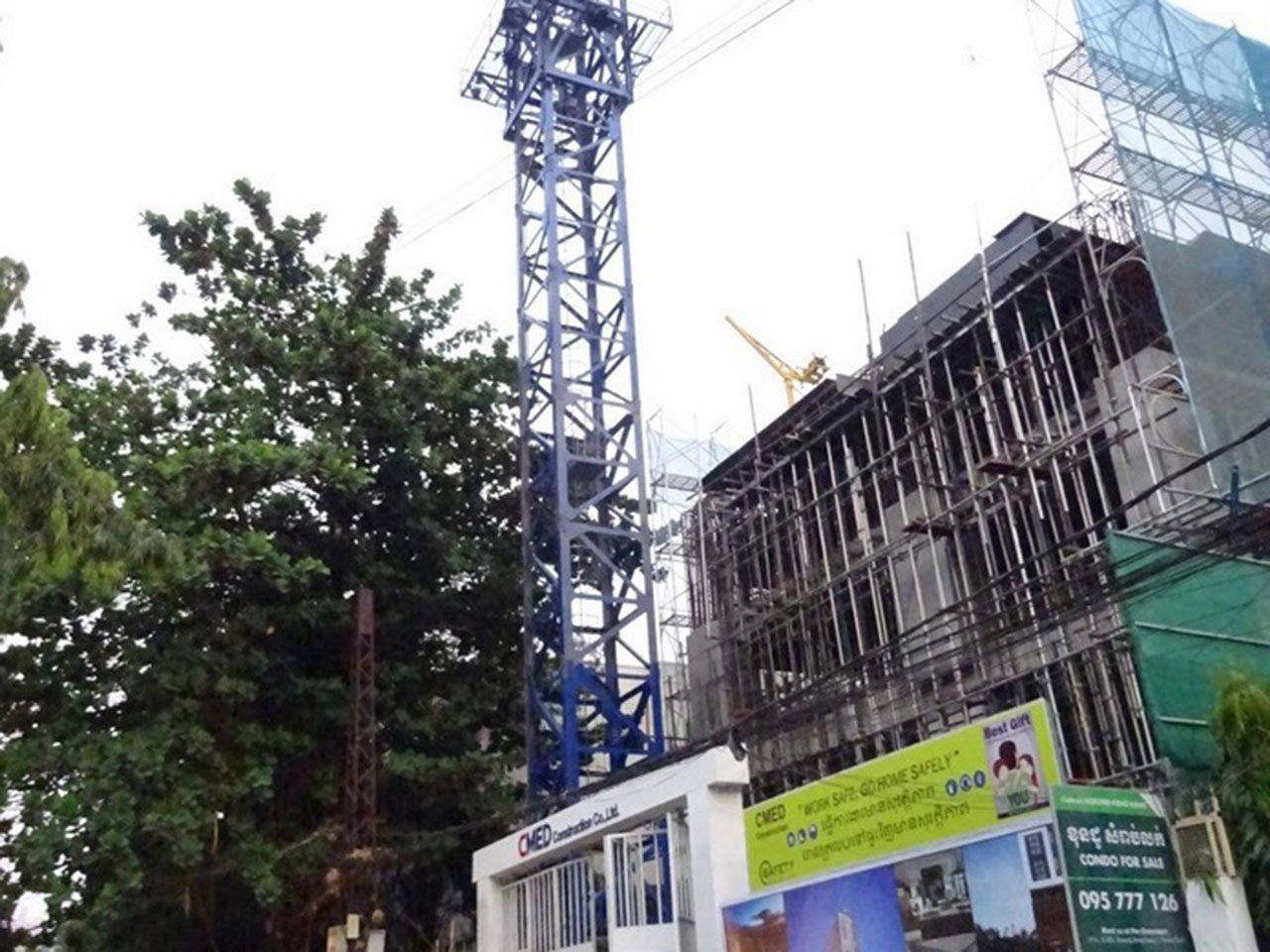

October 2018

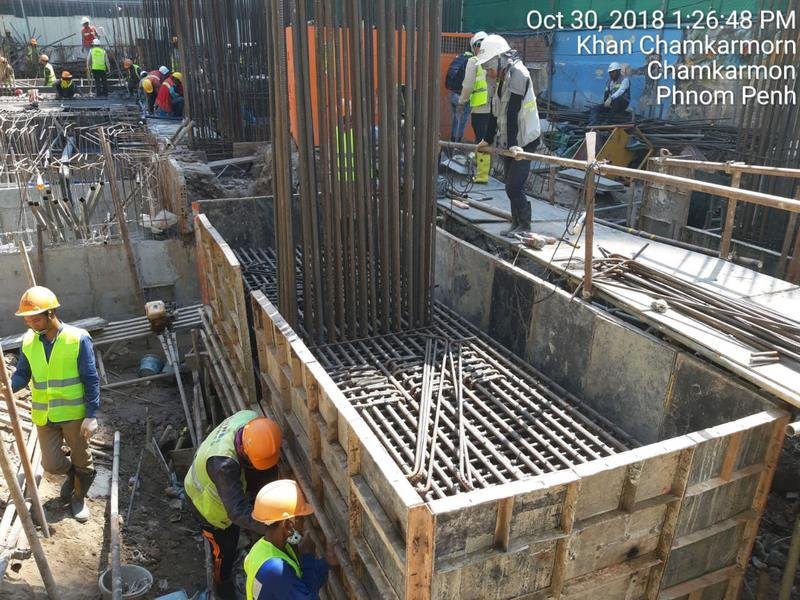

Sub structure works in progress – Shoring, excavation, footing, pile cap, tie beam, underground water tank, elevator pit, car lift pit.

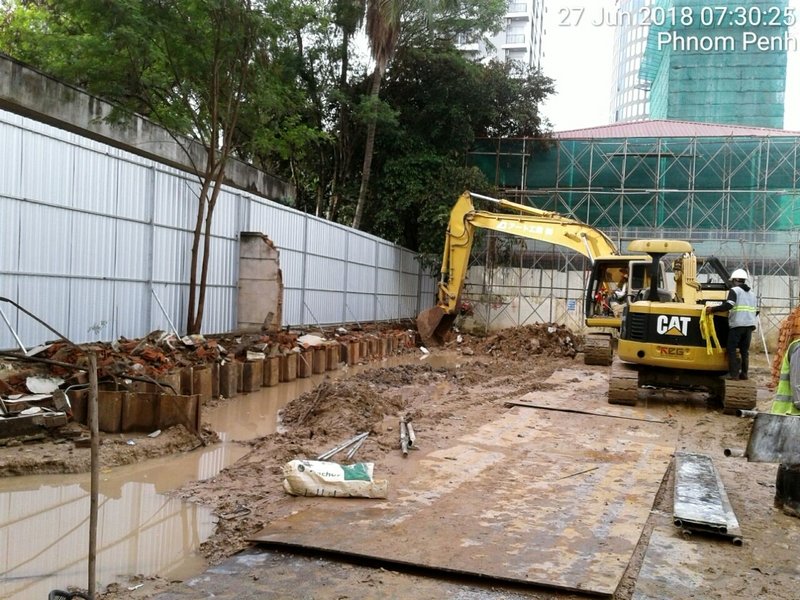

June 2018

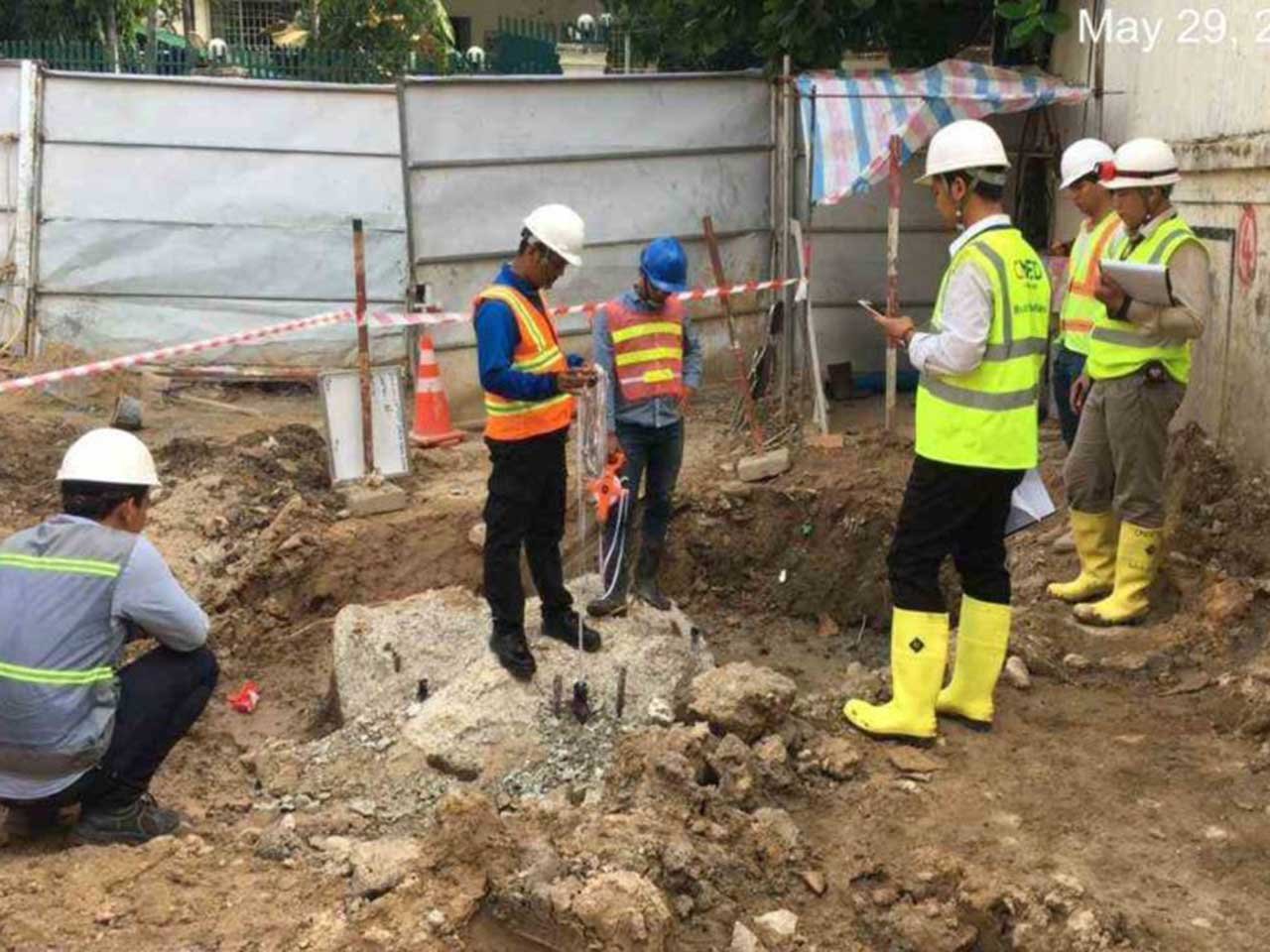

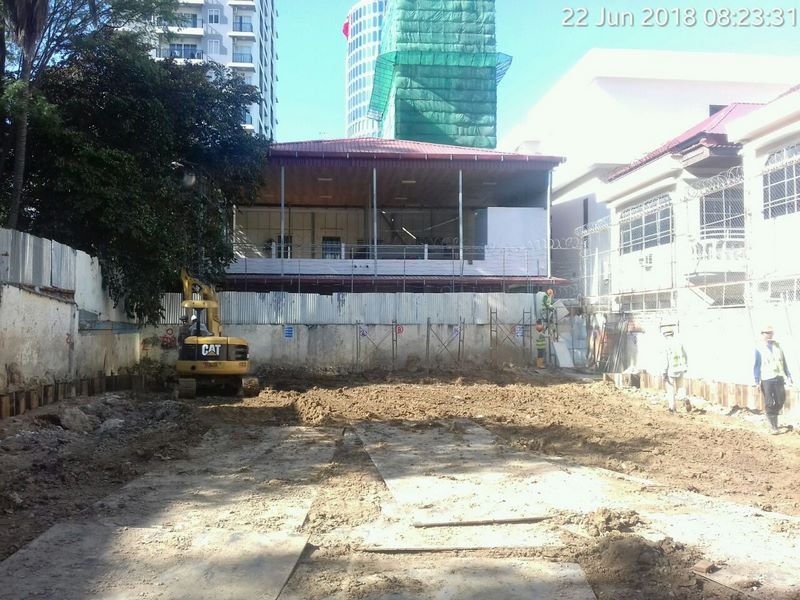

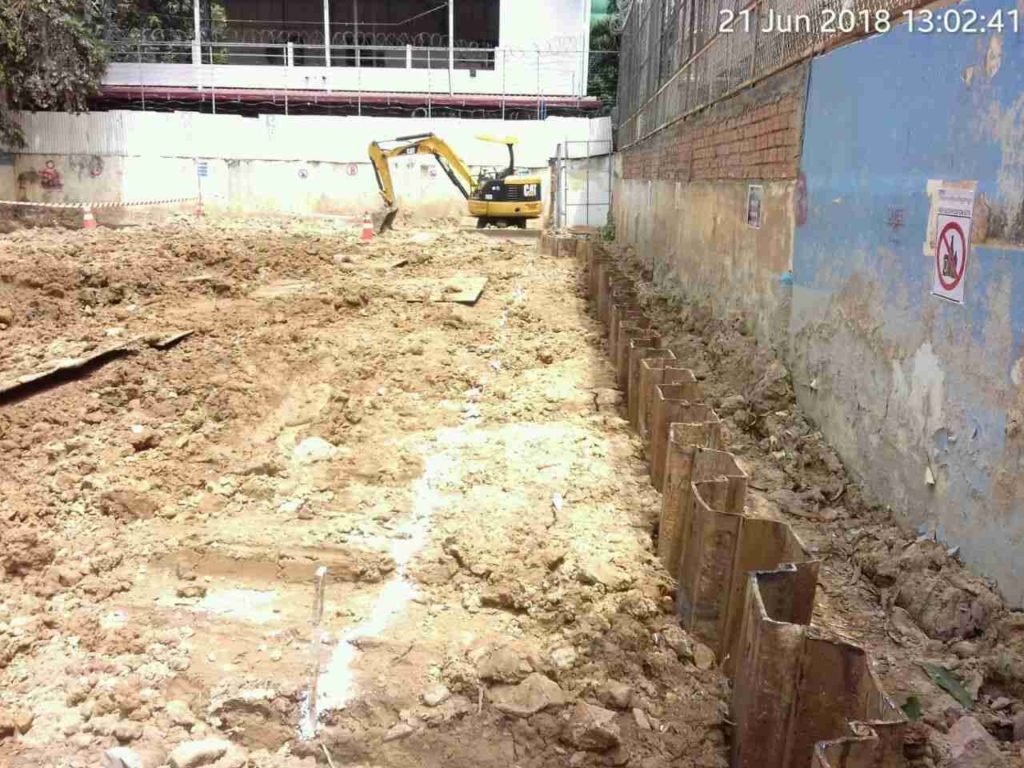

Bored pile – PIT, Sonic test, sheet piling for protection of excavation works.

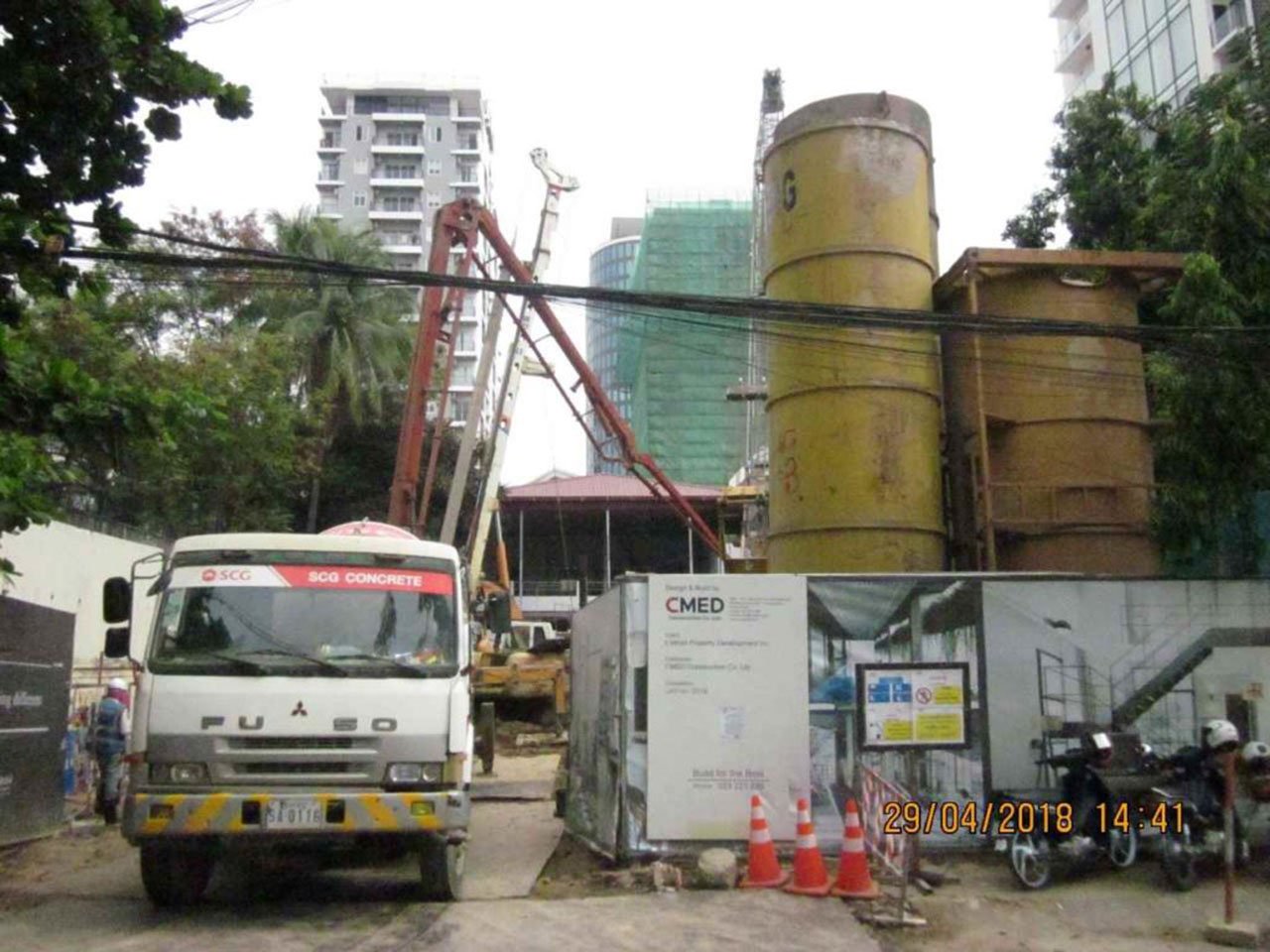

April 2018

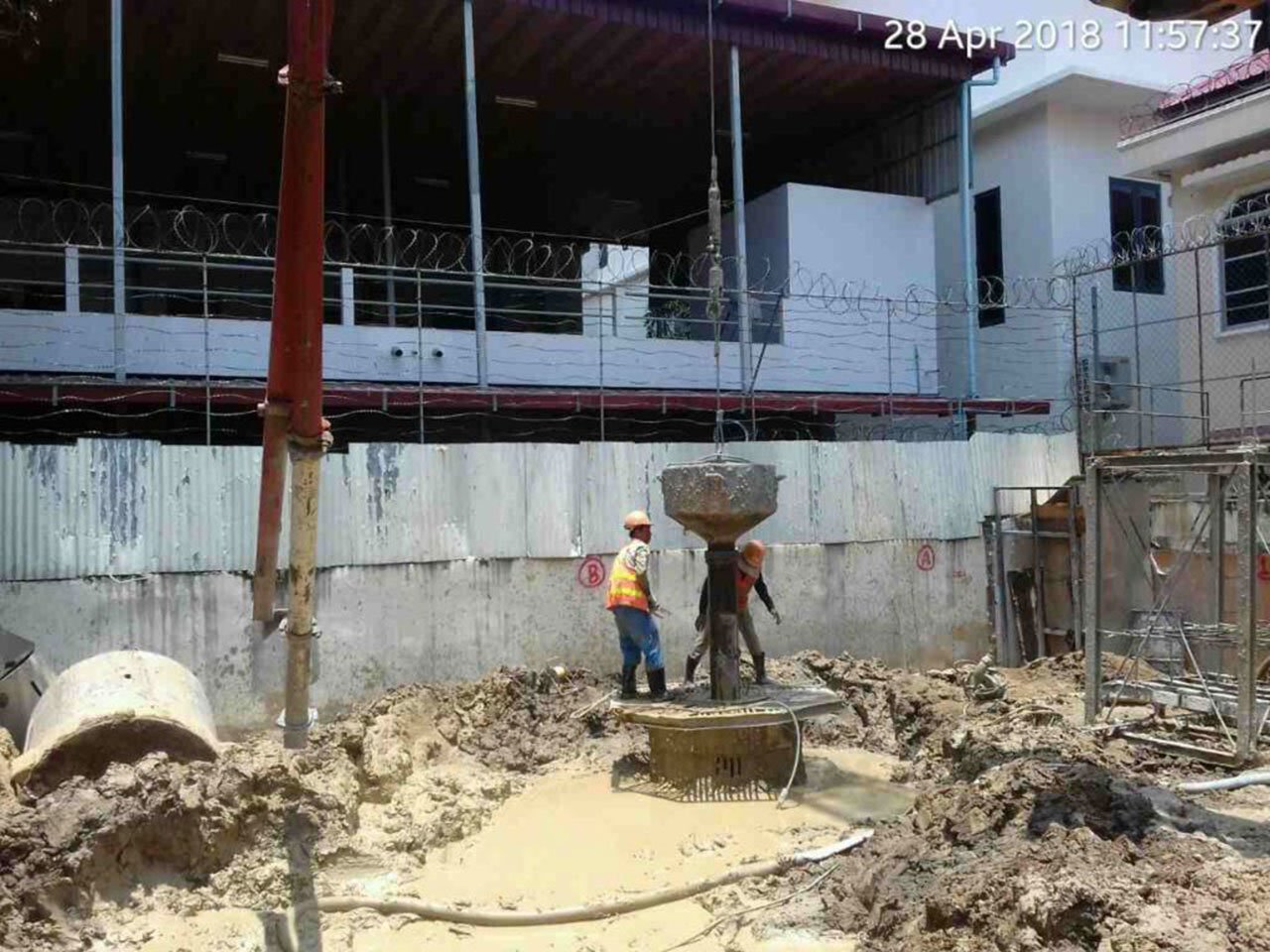

Bore pile works in progress



2020.04.24
