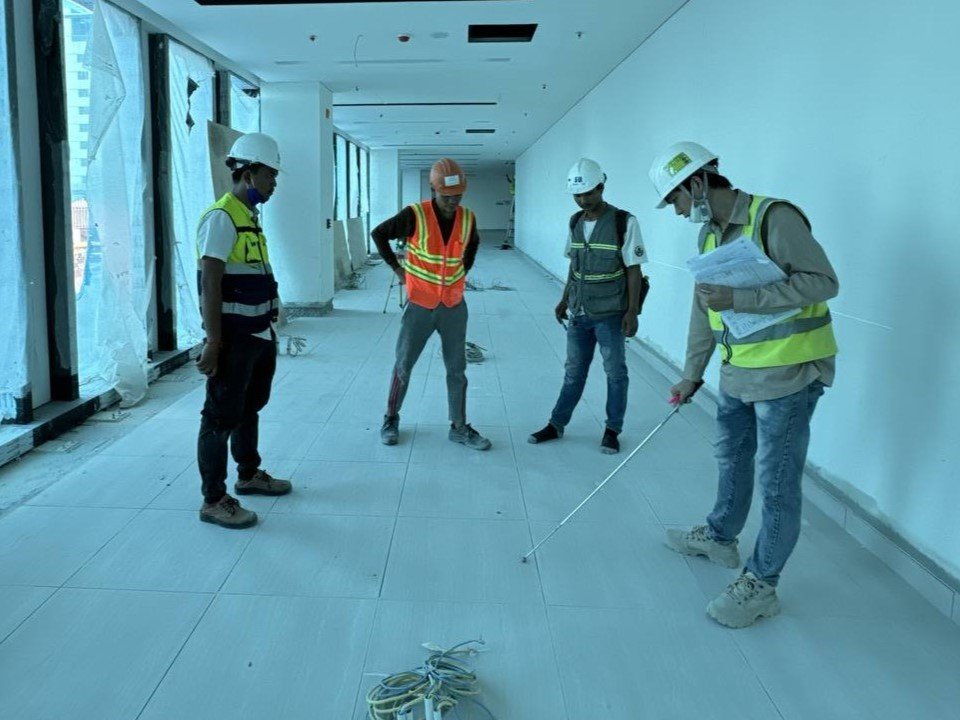

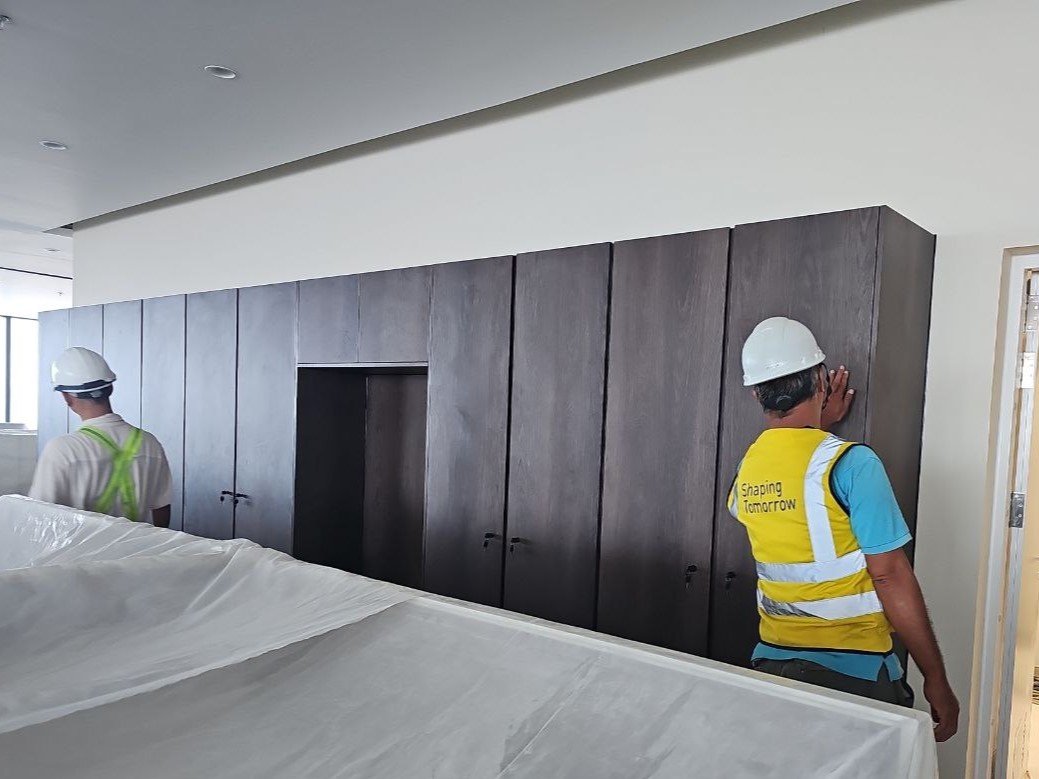

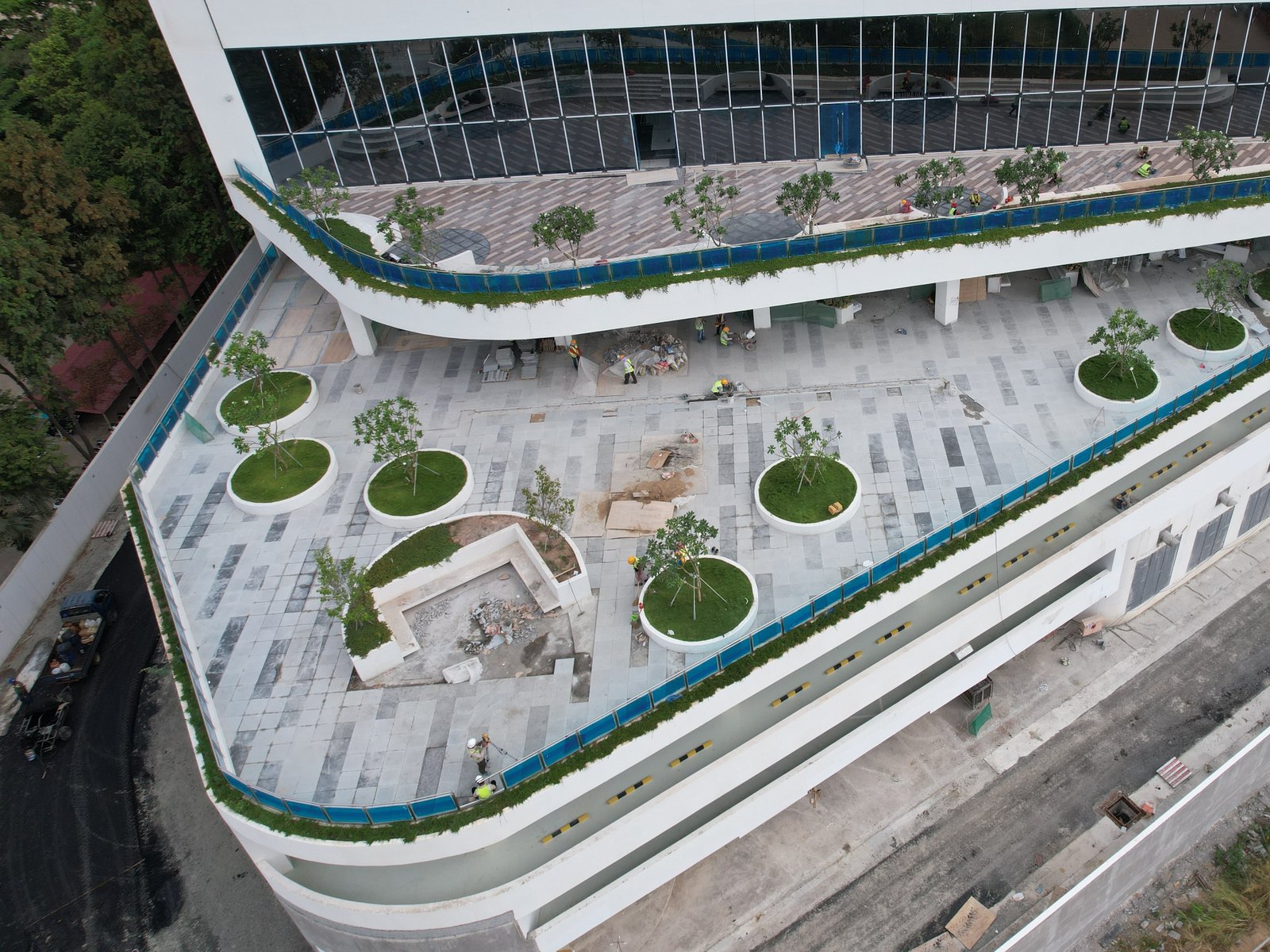

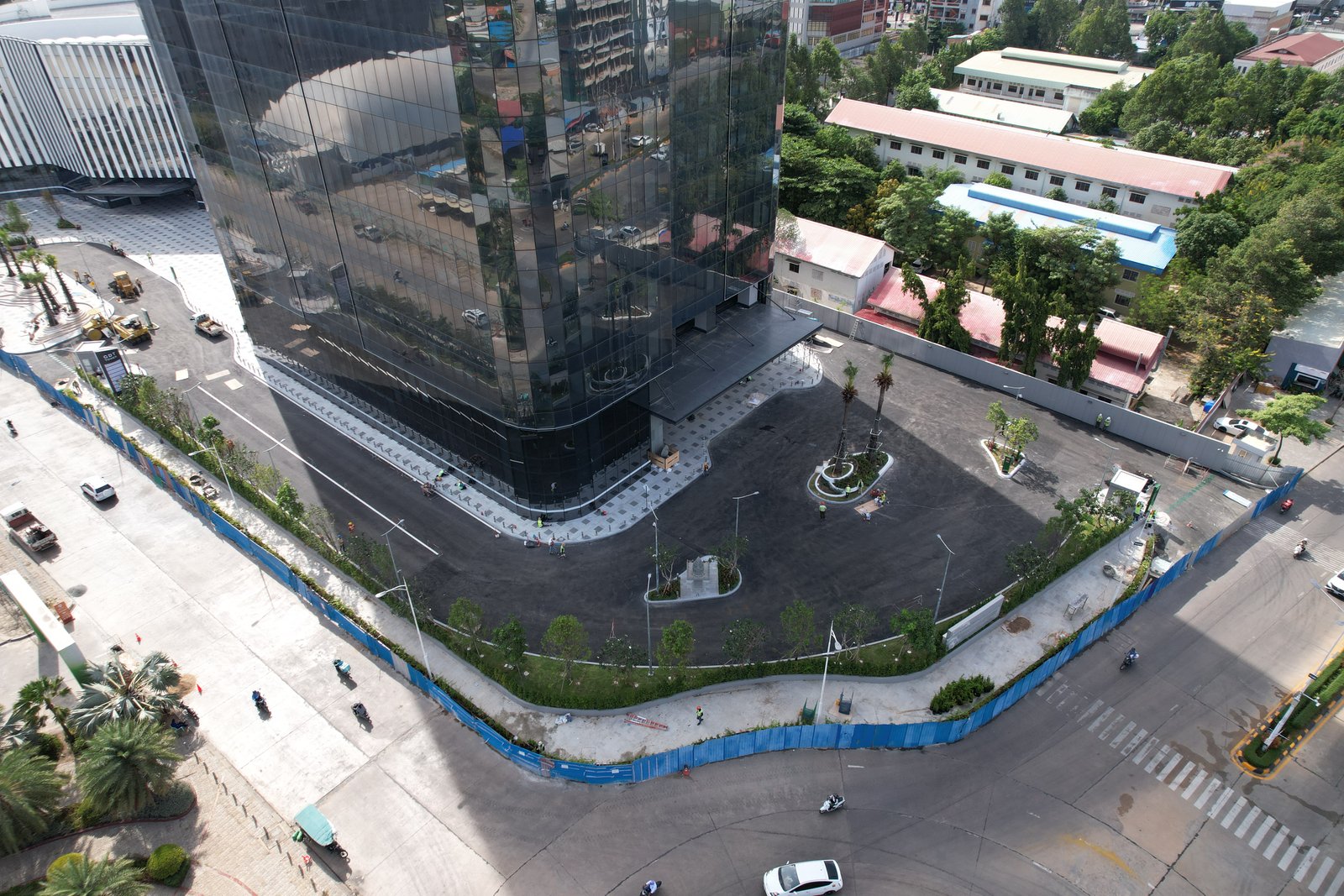

PODIUM BUILDING: Roofing, plastering, paintworks, curtain wall, skylight, escalator/elevator installation, floor/ceiling work, tiling, epoxy coating (car park). MEP second fix, switchgear installation, external excavation/painting, glass railing.
TOWER BUILDING: Topping off ceremony, CHB block work, internal plastering, floor screeding, waterproofing, septic tank construction,
ceiling/floor/wall works, MEP second fix, BMU installation.
PODIUM BUILDING: Roofing, plastering, escalator/elevator installation, screeding, ceiling closing board, MEP second fix, genset and chiller installation, backfilling.
TOWER BUILDING: Superstructure for slab LR, CHB block work, internal plastering, floor screeding, waterproofing, septic tank construction,
curtain wall, floor/wall tile, MEP second fix.

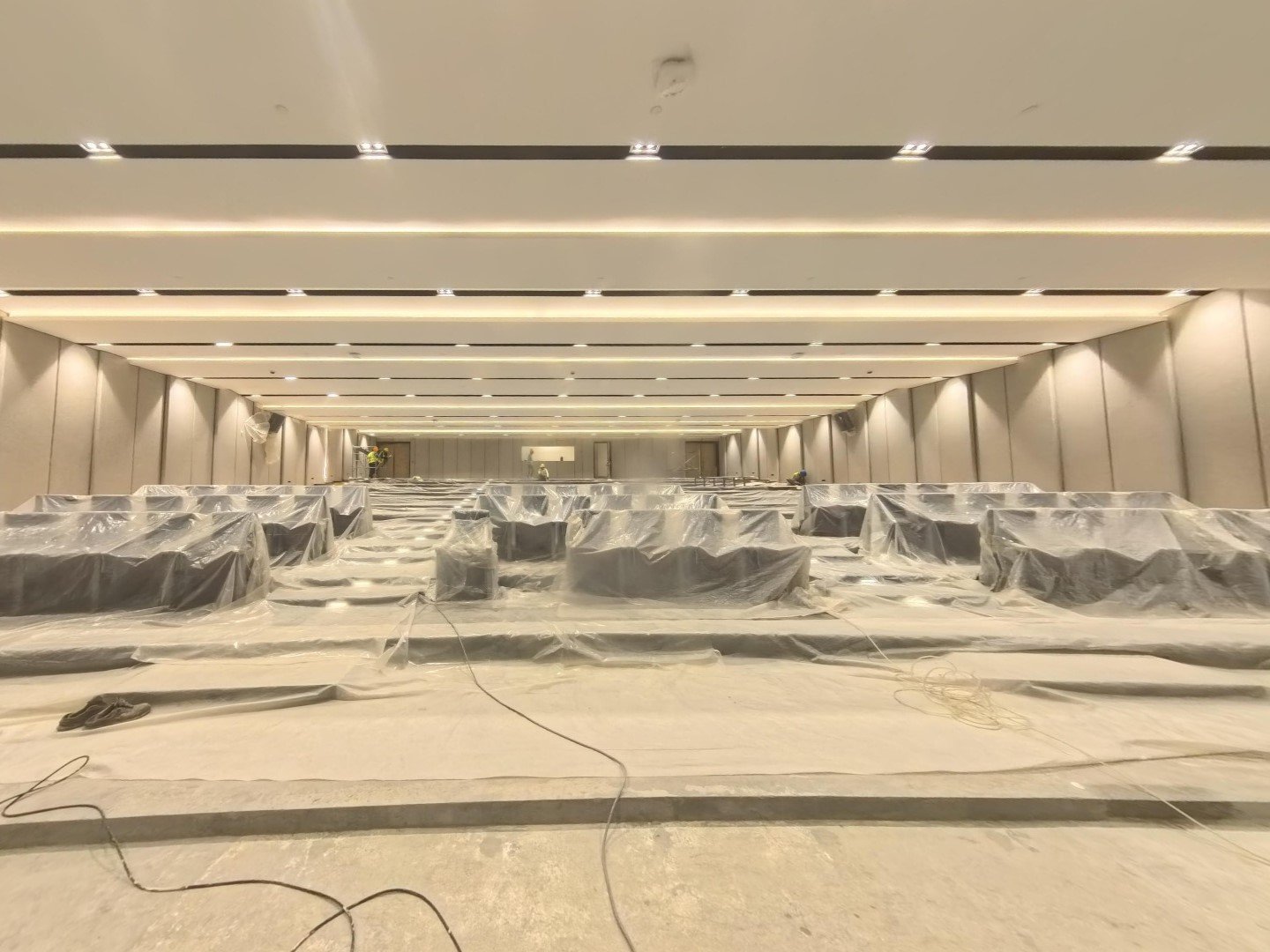

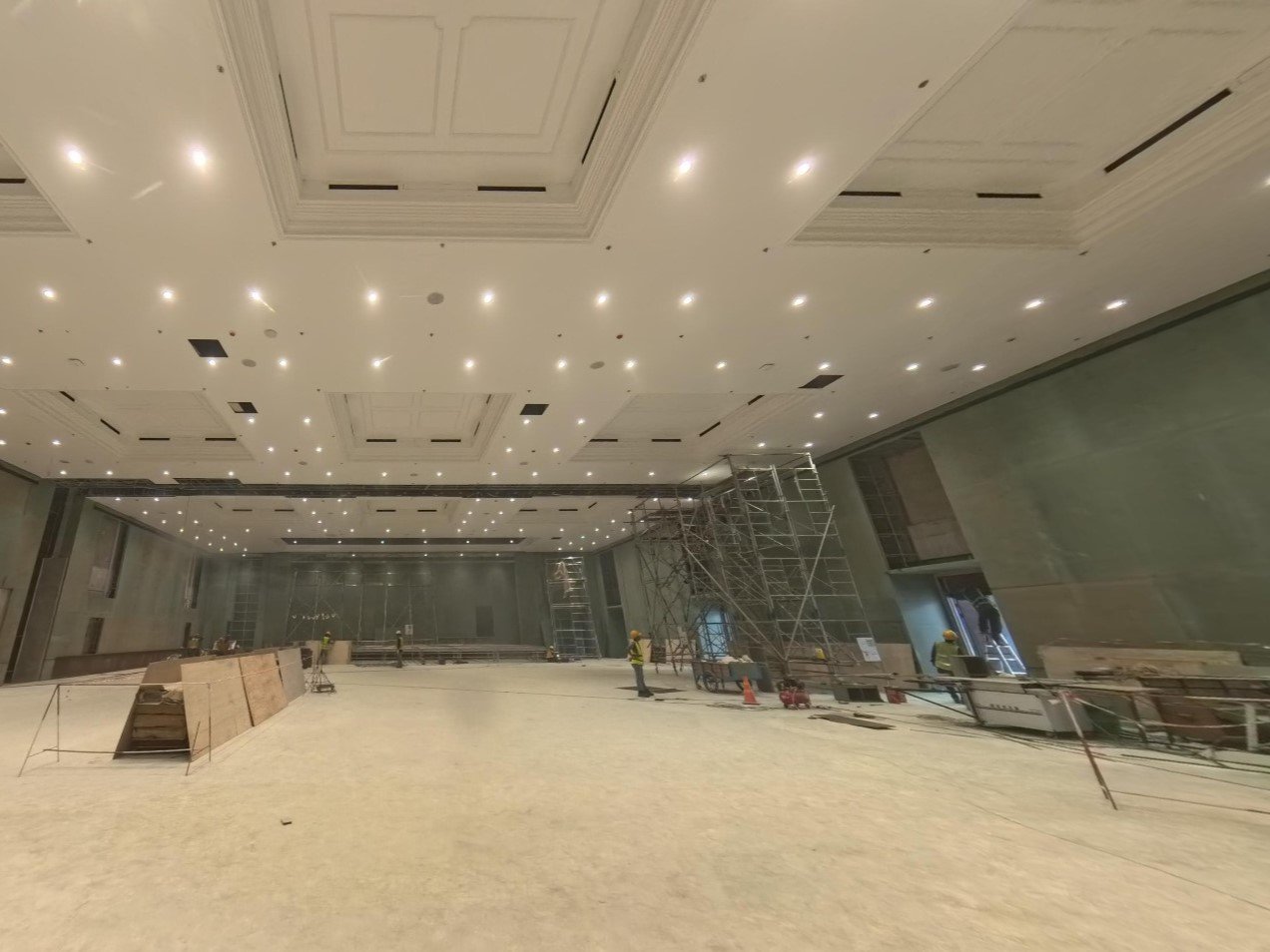

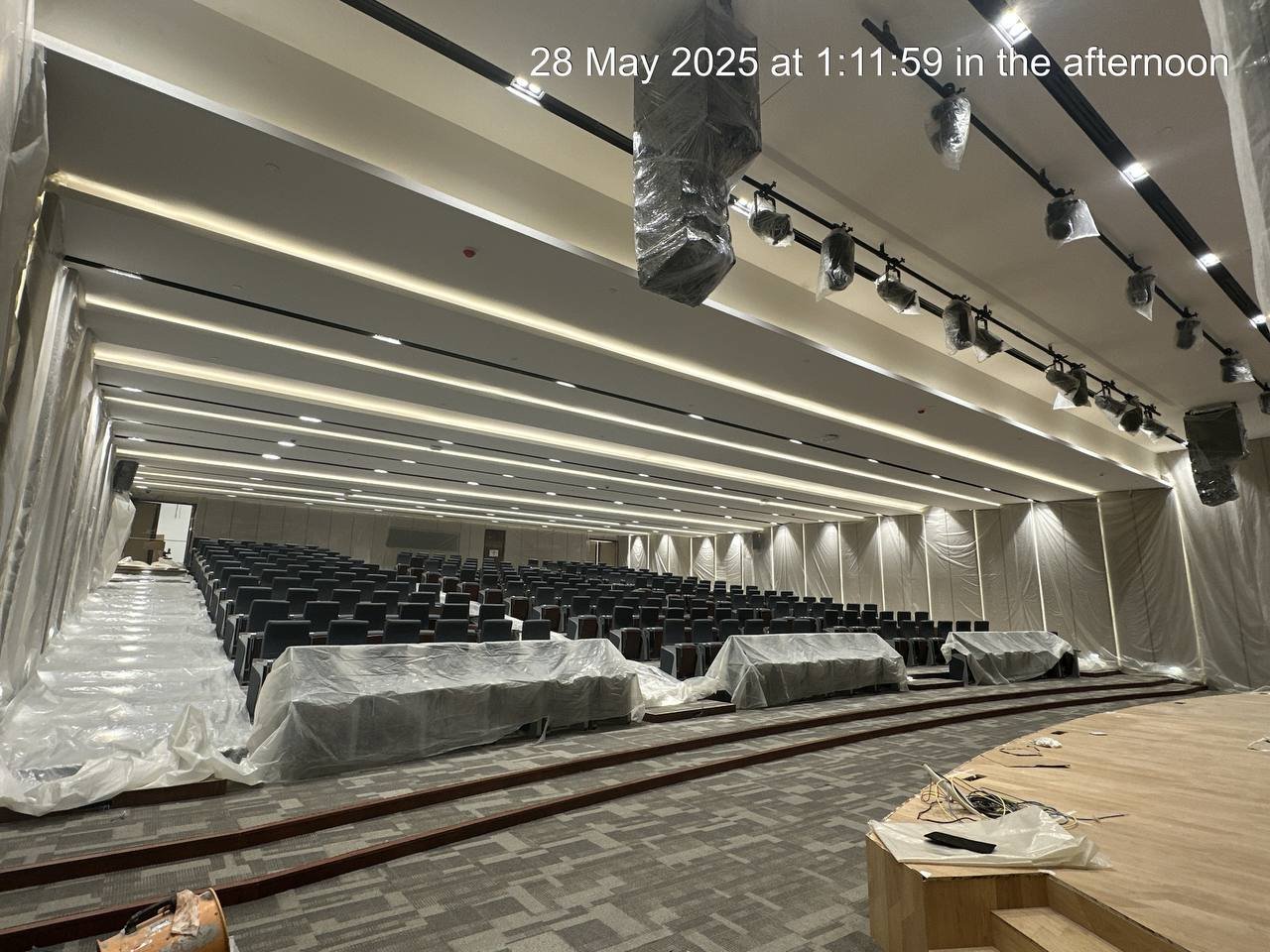

PODIUM BUILDING: Roofing, Plastering work, Wall and Soffit Slab Skim coat, painting, waterproofing, Curtain Wall, skylight, Installation of Escalator, Elevator, Floor screeding, Ceiling Frame and MEP second Fix in progress, Installation of Switchgear
TOWER BUILDING: Super structure for Slab LR, CHB block work, Internal Plastering, Floor screeding, waterproofing, construction of Septic tank, curtain wall, Genset installation, chiller installation and MEP second fix in progress
PODIUM BUILDING: Roofing, Plastering work, Wall and Soffit Slab Skim coat, painting, waterproofing, Curtain Wall, skylight, Installation of Escalator, Elevator, Floor screeding and MEP second Fix in progress
TOWER BUILDING: Super structure for Slab L26 to L28, Core wall L29 to LR, CHB block work, Internal Plastering, Floor screeding, waterproofing, construction of Septic tank and MEP second fix in progress

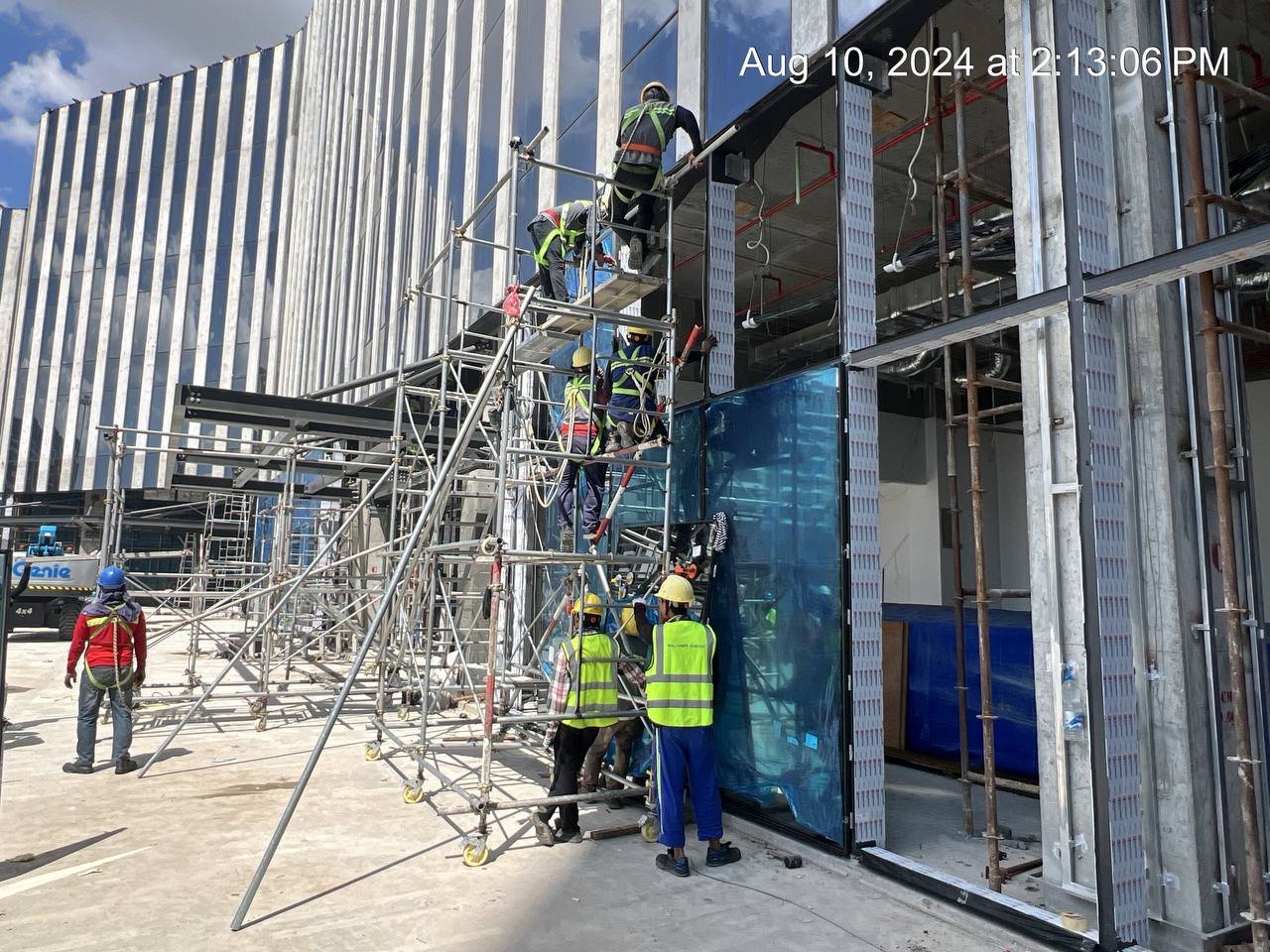

PODIUM BUILDING: Steel Structure, CHB Block Work, Plastering work, Wall and Soffit Slab Skim coat, painting, waterproofing, Curtain Wall, skylight, Installation of Escalator and MEP second Fix in progress, Chiller room, Transformer, Genset
TOWER BUILDING: Super structure for Slab L17 to L21, Core wall L20 to L25, CHB block work, Internal Plastering and MEP second fix in progress
PODIUM BUILDING : CHB Block Work, Plastering work, Wall and Soffit Slab Skim coat, Curtain Wall Visual Mock-up installed and ready for inspection , and MEP second Fix in progress
TOWER BUILDING : Super structure for Slab L12 to L14, Core wall double height Floor L15 to L16, CHB block work, Internal Plastering and MEP second fix in progress
PODIUM BUILDING : Superstructure Work, CHB Block Work and Plastering Work and backfilling work, External Scaffolding Work In Progress.
TOWER BUILDING : L5 to L6 slab, Core Wall and Column L5 to L8 Work, L5 Lobby Concreting Work, DOKA System Formwork for core wall and slab In Progress.
PODIUM BUILDING : Superstructure Work, CHB Block Work and Plastering Work, Extracting sheet pile and backfilling work, External Scaffolding Work In Progress.
TOWER BUILDING : L2 to L3 slab, Lift Core Wall and Column Work, L3 Lobby Concreting Work, DOKA System Formwork In Progress.
PODIUM BUILDING : Superstructure Work, CHB Block Work and Plastering Work, Extracting sheet pile and backfilling Work in Progress.
TOWER BUILDING : GF slab, Lift Core Wall and Column GF to L3 Work, L2 Lobby and L3 Concreting Work in Progress.
PODIUM BUILDING : Substructure and Superstructure Work, Block Work Basement B1 and B2 In Progress.
TOWER BUILDING : GF slab, Lift Core Wall and Column GF to L3 Work, Slab L2 and L3 formwork In Progress
PODIUM BUILDING : Substructure & Super structure, block work for boundary Wall In Progress
TOWER BUILDING : Excavation, Bored Pile Testing Works, Pile Cap, Lift Pit, hacking pile head, Backfilling Works for GF slab In Progress
PODIUM BUILDING : Basement, Pile cap, Ground Beam, Slab works in Progress
TOWER BUILDING : Pile cap, Lift pit excavation, hacking pile head work in Progress
GENERAL AREA : De-watering and housekeeping for the site overall
Completion of bored pile driving at tower
Bored pile test (PDA and Sonic test) at tower
Sheet pile driving at lift pit tower
Basement slab concrete casting
Mezzanine slab concrete casting
Pile cap and column concrete casting
Pile cap block form work and lean concrete
Basement and mezzanine floor column formwork
Rebar pile cap, column, basement and mezzanine -slab rebar arrangement
Sand backfilling for basement slab Pile head excavation
Basement slab concrete casting
Basement slab rebar and column rebar arrangement
Pile cap block form work and lean concrete
Rebar pile cap and basement slab rebar arrangement
Pile cap concrete casting
Bored pile drilling and concrete casting
First Permanent Pile Drilling: 08 July 2022
2022.02.26
